Download presentation
Presentation is loading. Please wait.
Published byElla Dawson Modified over 6 years ago
1
DBE FTA Disadvantaged Business Enterprise Contract Goal Setting
Caltrans Office of Business & Economic Opportunity FTA
2
OBJECTIVE How to set DBE contract goals
3
OBJECTIVE How to set DBE contract goals What Why When
4
WHAT is a DBE goal? Percentage of the total contract amount that is expected to be performed by certified DBE firms.
5
WHY 49 CFR PART 26 DBE Program Recipient of federal transit funds
6
WHY 49 CFR PART 26 DBE Program Establish statewide DBE goal
7
WHY 49 CFR PART 26 FTA approved overall DBE G&M : 4.8%
8
WHY 49 CFR PART 26 Race-conscious (RC) program 1.1% RC + 3.7% RN
9
WHY 49 CFR PART 26 DBE goal set on FTA-funded contracts:
ADVERTISED ON OR AFTER OCT 1, 2017
10
WHEN Goal 0% goal No goal
11
WHEN a goal applies Subcontracting opportunities
Parts or material supply
12
WHEN 0% goal applies Very limited or narrow scope of work
Limited DBE availability Difference between a zero-percent goal and no goal. Capture potential participation
13
WHEN no goal applies Sole source Emergency relief
Sole source = proprietary Different from a non-competitively bid contract
14
First Poll Sole source = proprietary
Different from a non-competitively bid contract
15
WHEN to set goals After: Independent cost estimate
When is it time to set…
16
Independent Cost Estimate
Items of work and estimated values established
17
HOW to set a goal SEVEN STEPS Seven Basic steps.
Next slide provides an overview then we’ll spend more time reviewing each step
18
HOW to set a goal Identify work items typically performed by prime; element of material supply Determine work category codes for sub work items Search the CA Unified Certification database Apply factors to sub work (100%, 12%) Calculate a preliminary goal Multiply by 60% factor Round to whole % for contract goal
19
STEP ONE Identify work items typically performed by Prime Consultant or Contractor, i.e., firm awarded the contract, and…
20
STEP ONE Identify work items with opportunities for parts or material supply
21
PRIME ITEMS Prior projects Project Managers Where’s the money
Don’t assume there are no subcontracting opportunities because the Prime performed all of the work on a similar job and on the other hand, don’t assume that all work can be subcontracted leaving no work for the prime Proj Mgrs: historical knowledge, items that could be subcontracted or an opportunity for material supply $: prime = perform high-value items.
22
STEP ONE Actual subrecipient project. Prime consultant
23
STEP ONE
24
STEP TWO Determine work category codes for Subcontractor work items
25
Excel spreadsheet
26
Work Category Code List
Work Category Code List Excel spreadsheet
27
Work category codes Tabs: Professional services & All Industries
28
Need screen shot ofconsultant or construction project
Apply work category codes Need screen shot ofconsultant or construction project
29
Second Poll Sole source = proprietary
Different from a non-competitively bid contract
30
STEP THREE Perform search by District for DBE availability
31
STEP THREE Query CALIFORNIA UNIFIED CERTIFICATION PROGRAM (CUCP) database District • Work Category Code
32
CUCP
33
CUCP database District Work Code District project is located.
Wk Code: I7810-Motion picture & video tape production
34
CUCP search results Note to use “Back to Query Form” hyperlink rather than browser back button
35
CUCP search results Note to use “Back to Query Form” hyperlink rather than browser back button
36
STEP THREE
37
STEP FOUR Apply work estimate factors
38
STEP FOUR Sub Materials ≥ 10 DBEs
39
STEP FOUR
40
STEP FIVE Calculate a “Soft Goal” DBE $ Total $
41
STEP FIVE $10,750 $861,225
42
STEP FIVE 1.25%
43
Third Poll Sole source = proprietary
Different from a non-competitively bid contract
44
STEP SIX Multiply goal by 60% factor
45
STEP SIX Over-representation Competition
10 firms: 6 are ready, willing and able to perform on your contract.
46
STEP SIX 1.25% x 60% = .75%
47
STEP SEVEN Round goal to nearest whole percent
48
STEP SEVEN .75% = 1%
49
EXAMPLES
50
EXAMPLE 1.1 Emphasize Accountability: Zero-percent goal vs no goal. Accountability.
51
EXAMPLE 1.2
52
EXAMPLE 2 I7336-COMMERICAL ART AND GRAPHIC DESIGN
D2750-COMMERCIAL PRINTING C8712-PUBLIC RELATIONS
53
EXAMPLE 3 I7336-COMMERICAL ART AND GRAPHIC DESIGN
D2750-COMMERCIAL PRINTING C8712-PUBLIC RELATIONS
54

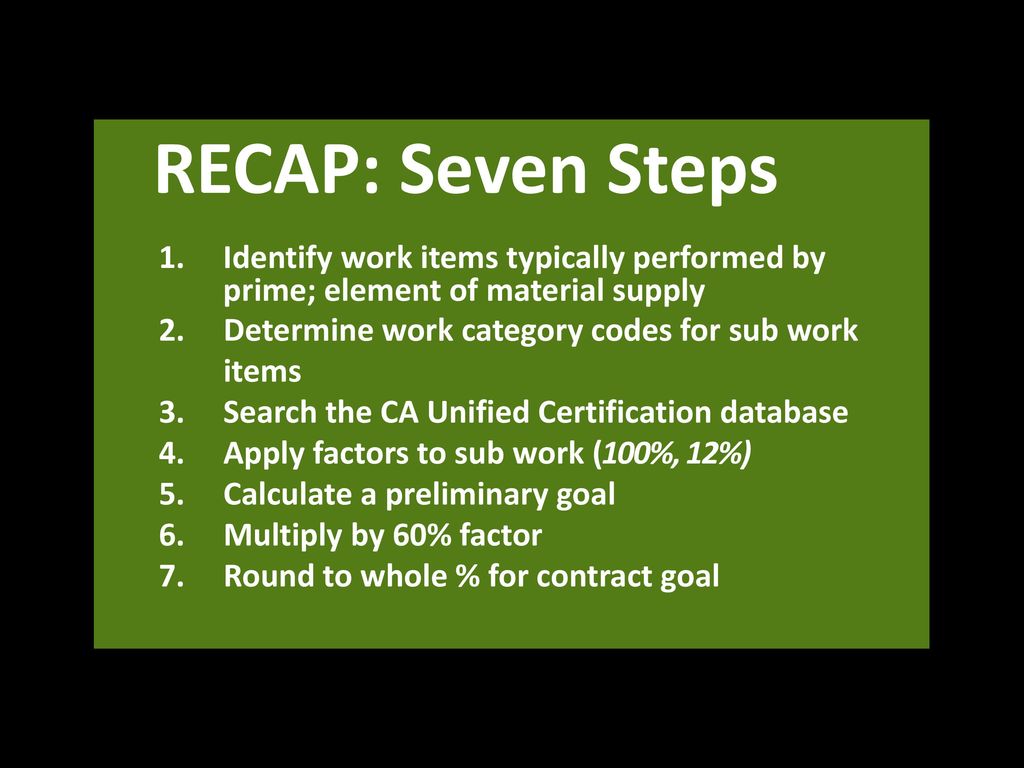

RECAP: Seven Steps Identify work items typically performed by prime; element of material supply Determine work category codes for sub work items Search the CA Unified Certification database Apply factors to sub work (100%, 12%) Calculate a preliminary goal Multiply by 60% factor Round to whole % for contract goal
55
TIPS Suppliers Contingency $
56
TIPS Set a DBE goal ADVERTISED ON OR AFTER OCT 1, 2017
57
CALTRANS APPROVAL Before advertisement: 0% DBE goal or ≥ $750,000
Submit to Caltrans for approval Caltrans will confirm or revise goal
58
SUBMIT GOAL WKSHEET DOT.FTADBEGoal@ dot.ca.gov
Submit to Caltrans for approval Allow 15 working days for review
59
REMINDER DBE Commitment: ADM-0227F
Utilization/payment (ALL Subs/Suppliers): ADM-3069
60
COMING SOON Update to the State Management Plan
61
Last Poll Sole source = proprietary
Different from a non-competitively bid contract
62
OBJECTIVE How to set DBE contract goals
63
QUESTIONS DOT.FTADBEGoal@ dot.ca.gov
Mailbox for contract goal questions and approvals Forms: follow form instructions
64
WEBSITES Caltrans: www.dot.ca.gov
Division of Rail & Mass Transportation: Division of Transportation Planning: Division of Local Assistance: Office of Business & Economic Opportunity:
65
POST ASSESSMENT Thank you for attending today’s webinar!
Division of Rail & Mass Transportation Division of Transportation Planning Division of Local Assistance Office of Business & Economic Opportunity ©2017 California Department of Transportation. All rights reserved.
