ATC Major Projects Update Flora Flygt, Director of System Planning Franc Fennessy, Manager of Local Relations Wisconsin Industrial Energy Group August.

Similar presentations


Presentation on theme: "ATC Major Projects Update Flora Flygt, Director of System Planning Franc Fennessy, Manager of Local Relations Wisconsin Industrial Energy Group August."— Presentation transcript:

1 ATC Major Projects Update Flora Flygt, Director of System Planning Franc Fennessy, Manager of Local Relations Wisconsin Industrial Energy Group August 9, 2007 Madison, WI

2 2 Access Initiative  Goal: Reduce delivered cost of energy to Wisconsin consumers by... –reducing system congestion –improving access to additional energy sources  Solution: Add an additional 345 kV circuit to the existing 345 kV line (W4) between Rockdale SS (Dane) and Paddock SS (Rock)  Project estimated costs (2010): –Preferred route: $132.7 million –Alternate route: $210.8 million

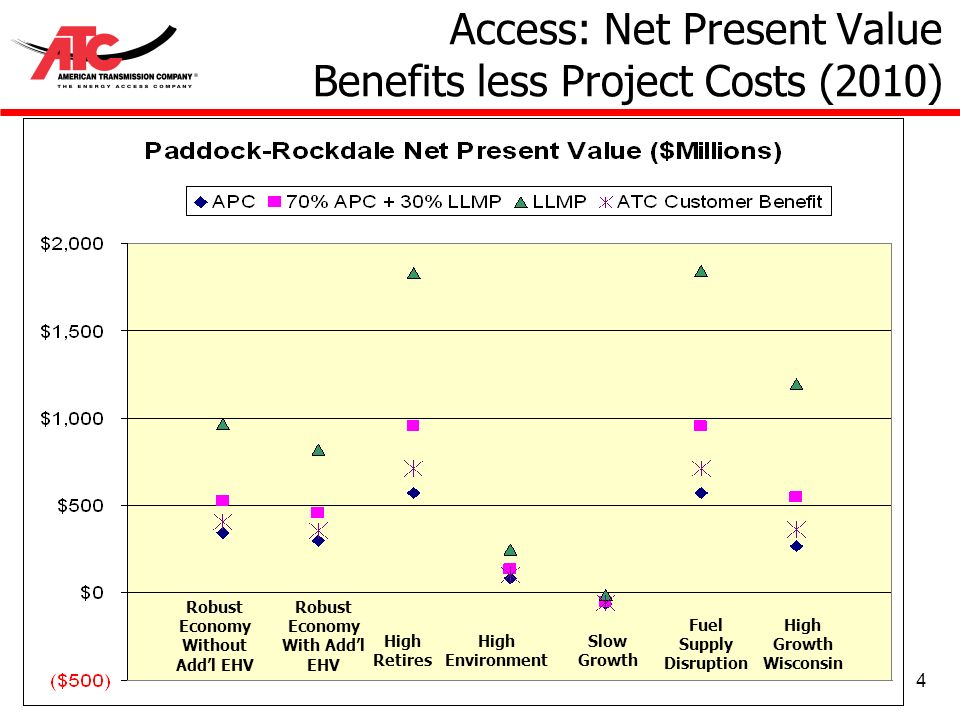

3 3 Access: Net Present Value Benefits less Project Costs (2010) Paddock-Rockdale Analysis - NPV of Net Benefits (Costs) ($ Millions) Robust Economy No NALX -COL Robust Econom y High Retirements High Environmental Slow Growth Fuel Supply Disruption High Growth Wisconsin APC$341$299$574$82($62)$575$265 70% APC + 30% LLMP$529$455$950$132($47)$956$544 LLMP$968$819$1,826$249($12)$1,843$1,196 ATC Customer Benefit$409$356$710$104($56)$710$365 APC = Adjusted Production Costs LLMP = Load-weighted Locational Marginal Prices

4 4 Access: Net Present Value Benefits less Project Costs (2010) Robust Economy Without Add’l EHV Robust Economy With Add’l EHV High Retires High Environment Slow Growth Fuel Supply Disruption High Growth Wisconsin

5 Dane County Projects Update

6 6 Background  Dane County has experienced major economic growth in the last 25 years.  Three of Wisconsin’s top 5 fastest growing municipalities are in Dane County (Verona, Cottage Grove and Sun Prairie). (Includes municipalities with a population of 5,000 or more in 2005; data source: U.S. Census Bureau.)  Dane County’s electricity consumption is expected to continue to increase through year 2020.  System-reliability models indicate that new transmission lines will be needed in Dane County by 2008 and every few years thereafter to keep pace with this growing demand.  ATC proposed five projects to deal with this growth

7 7 Public Outreach  Extensive outreach on all Dane County projects –Energy Initiative Study – supported a group of stakeholders and traditional interveners in review of Dane County’s transmission needs –Project communications, open houses –Ongoing consultation with regulatory agencies –Extensive media relations –Polling –Advertising

8 8 Dane County Transmission Projects  North Madison-Huiskamp – approval 7/12/07  Femrite-Sprecher – in service  Fitchburg-Verona – application complete, pending hearings  Paddock-Rockdale – application complete, hearings set  Rockdale-West Middleton – routes announced in August

9 9 North Madison-Huiskamp Project (aka “Waunakee Project”)  Controversy early in project –39 different parties, two intervenor groups –More than 100 public hearing witnesses –Calls for ‘independent’ study  Excerpts from PSCW oral discussion of decision: –“Ebert said this agenda item represents probably the most pressing reliability challenge he has seen since becoming Chairman.” –“Ebert said the [PSC] was formed 100 years ago and was created precisely to conduct that independent review.”

10 10 Dane County 345 kV Project  Rockdale – West Middleton (Dane) –Resolves significant voltage and reliability issues in Madison area –Final routes were announced on August 1; PSCW filing in October 2007 –Considerable public involvement effort to date. Open houses this month –Underground options evaluated—will not be recommended by ATC –In-Service: 2013

11 11 Other 345 kV Projects  Arrowhead – Weston –On schedule & budget for June 2008  Gardner Park - Central Wisconsin –WPS Weston 4 generator interconnection –Early in construction; in-service 2009  Morgan – Werner West –System enhancement project in NE Wisconsin –Early in Construction; in-service 2009

12 12 Thanks! Questions? E-Mail: fflygt@atcllc.com ffennessy@atcllc.com Web: www.atcllc.com


Download ppt "ATC Major Projects Update Flora Flygt, Director of System Planning Franc Fennessy, Manager of Local Relations Wisconsin Industrial Energy Group August."
