1
Clinisys Bid By Carmen Lee Cameron Lake Bello Sulieman Nish Chandradas Joss Coombes

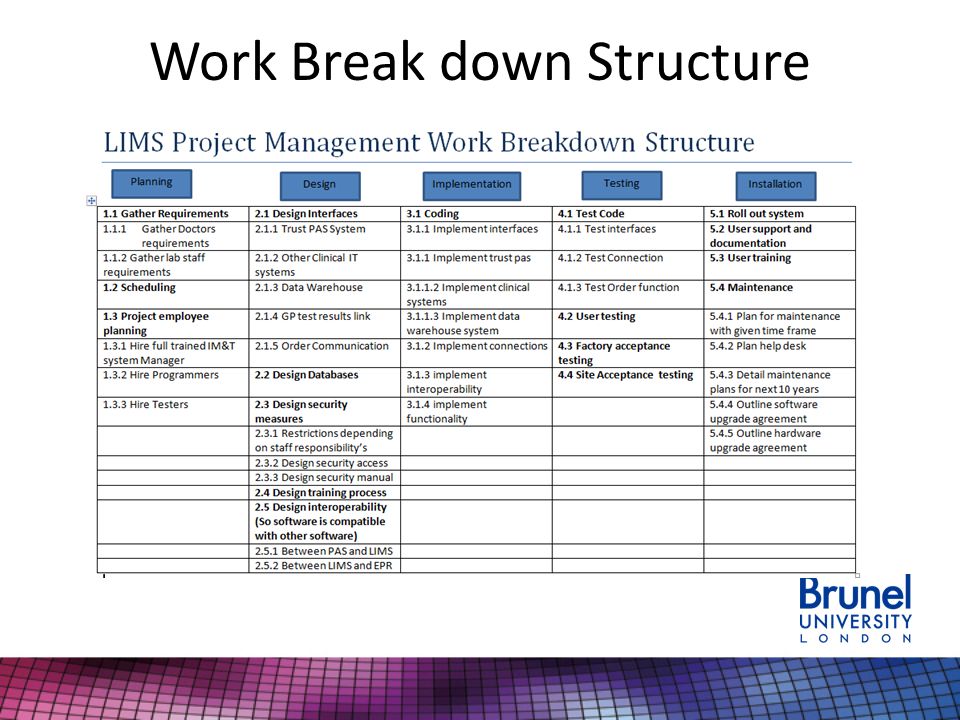

2
Work Break down Structure
3
Gantt Chart Development type Software SizeTeam Size Development life-cycle

4
Development cycle Team Size Software SizeDevelopment Type

5
Gantt Chart 4.6 months 4.7 months 14.7 months 6.7 months 2.2 months

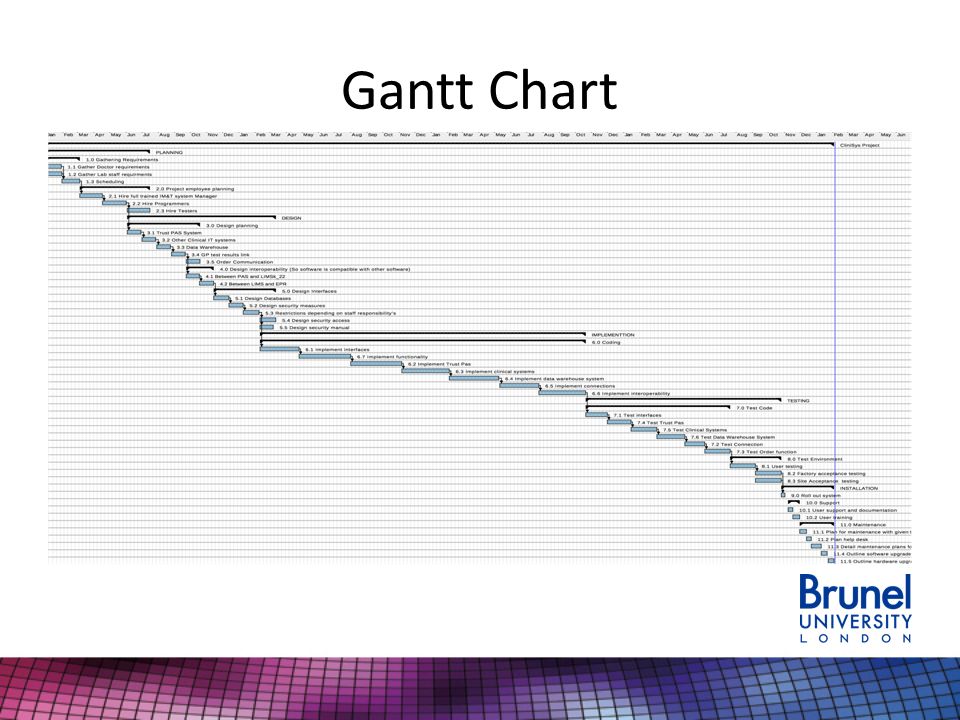

6
Gantt Chart

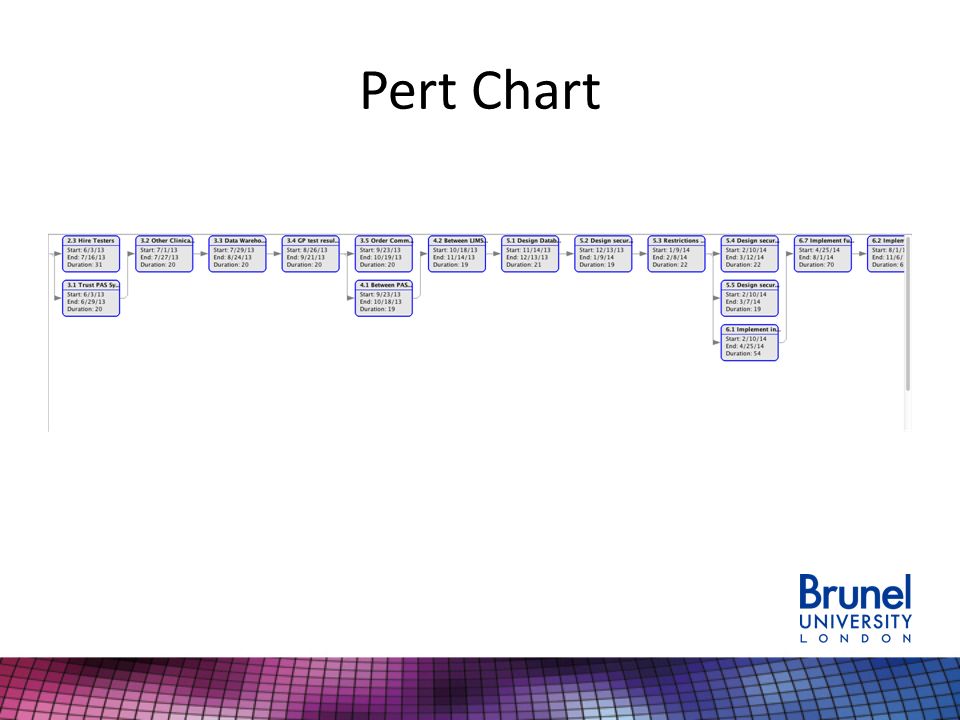

7
Pert Chart

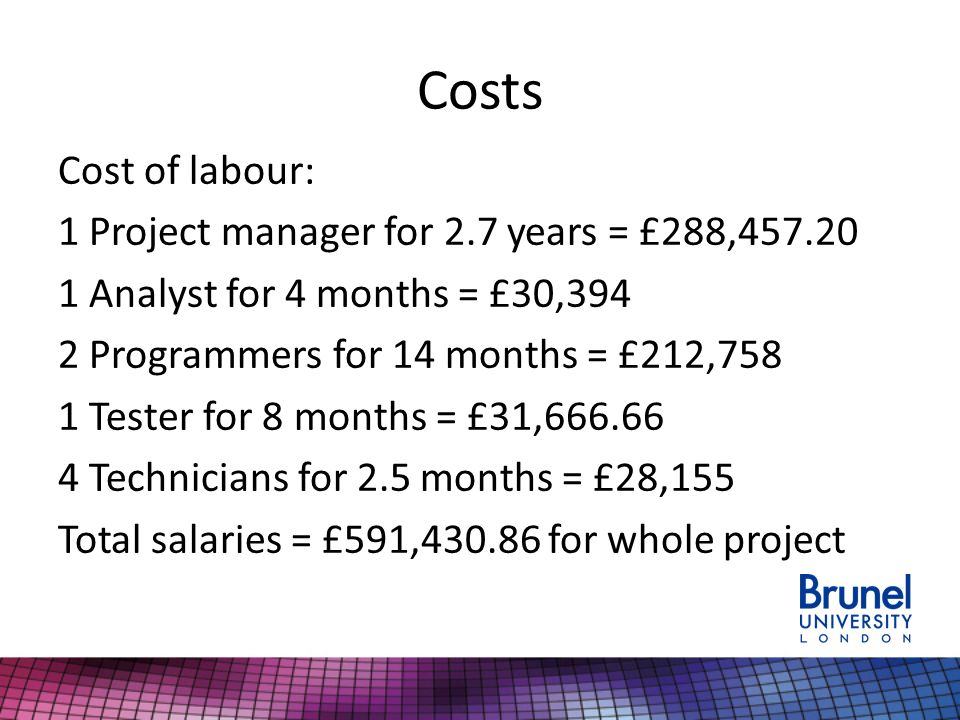

8
Costs Cost of labour: 1 Project manager for 2.7 years = £288,457.20 1 Analyst for 4 months = £30,394 2 Programmers for 14 months = £212,758 1 Tester for 8 months = £31,666.66 4 Technicians for 2.5 months = £28,155 Total salaries = £591,430.86 for whole project

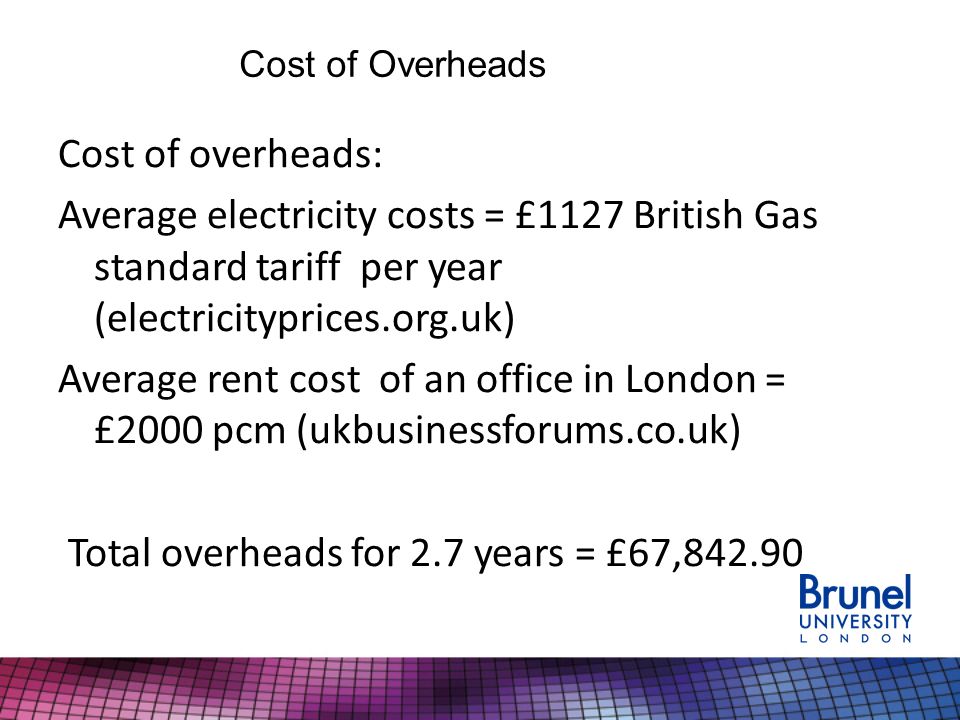

9
Cost of overheads: Average electricity costs = £1127 British Gas standard tariff per year (electricityprices.org.uk) Average rent cost of an office in London = £2000 pcm (ukbusinessforums.co.uk) Total overheads for 2.7 years = £67,842.90 Cost of Overheads

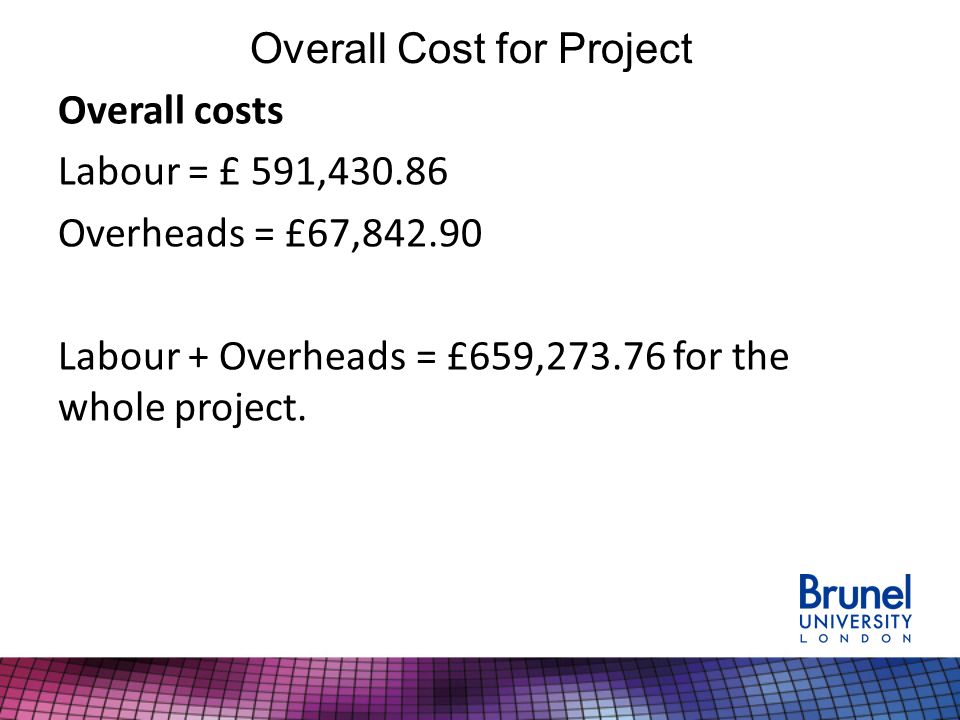

10
Overall costs Labour = £ 591,430.86 Overheads = £67,842.90 Labour + Overheads = £659,273.76 for the whole project. Overall Cost for Project

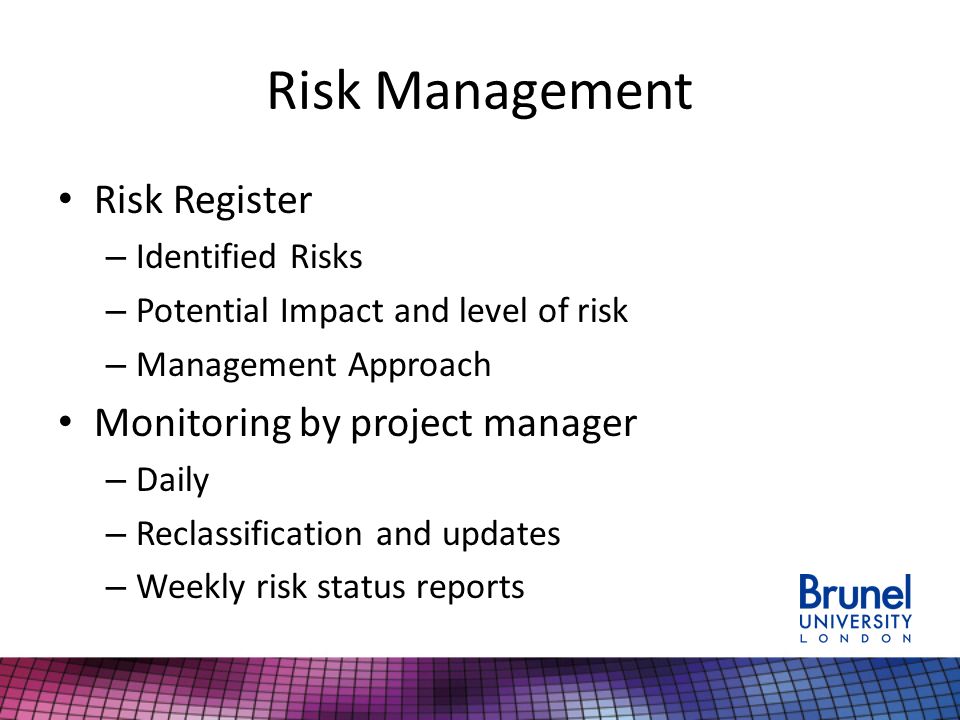

11
Risk Management Risk Register – Identified Risks – Potential Impact and level of risk – Management Approach Monitoring by project manager – Daily – Reclassification and updates – Weekly risk status reports
12
Primary Risks and Countermeasures Budget Limitation – PM will work with client to minimise costs and monitor expenditure throughout project. Disrupted service due to implementation/lack of familiarity with systems – Staff will receive training plans before implementation. Installation will be optimised to protect service Loss of Key Staff – Project team motivated by benefits. All positions covered by team member and contingency in event of unforeseen absence.
13
