Project Manager: Josh Hinkle Prepared for; Fran Lemieux J.H. Engineering Shaw Group
2

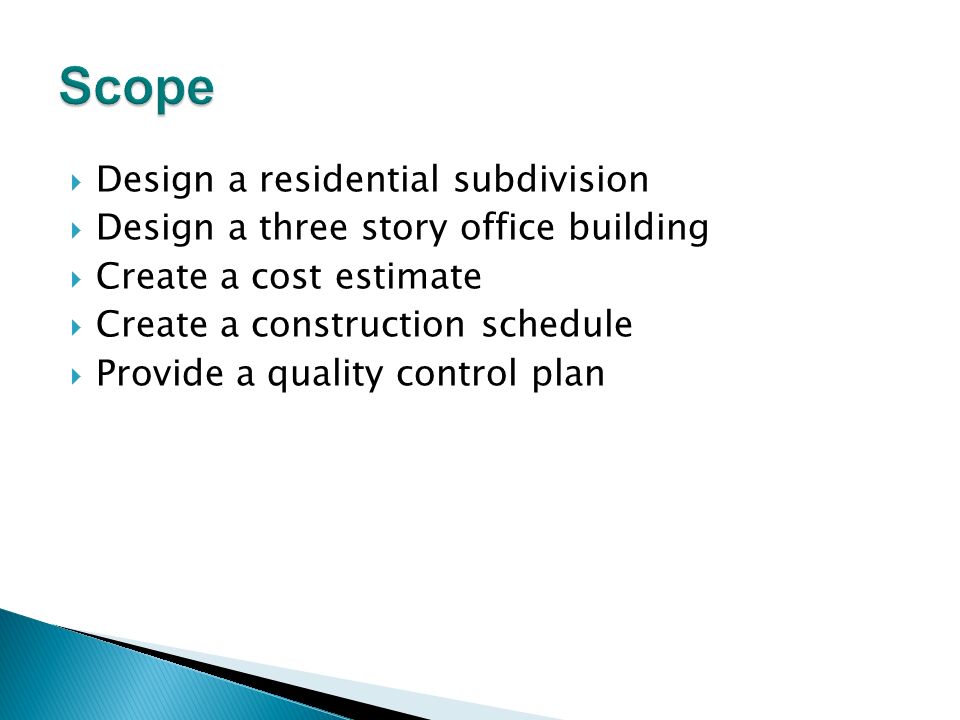

Design a residential subdivision Design a three story office building Create a cost estimate Create a construction schedule Provide a quality control plan
3

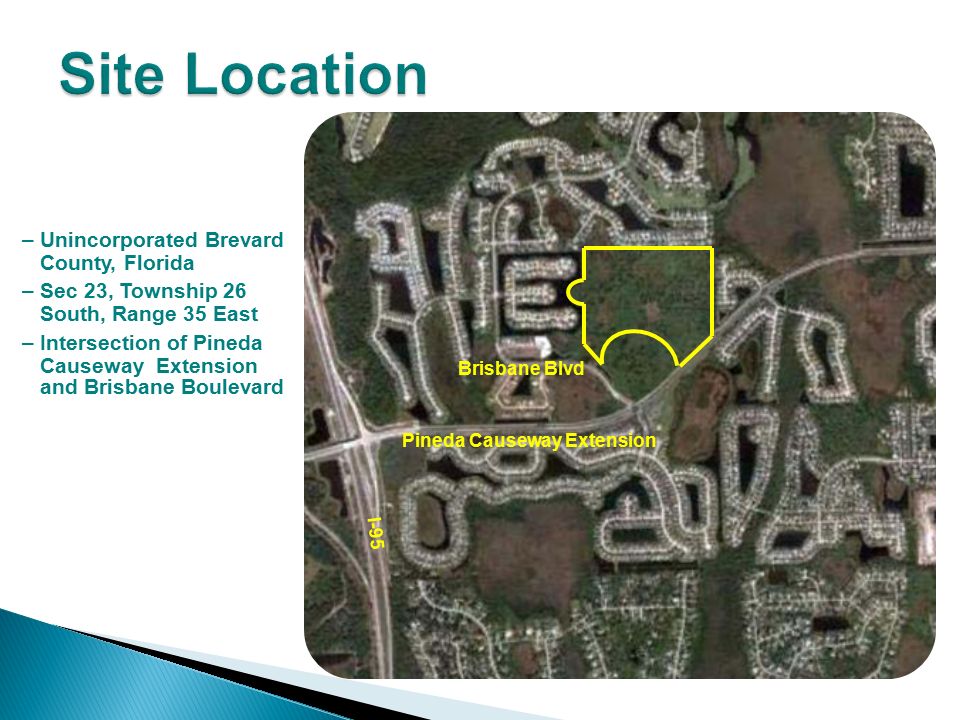

I-95 Pineda Causeway Extension Brisbane Blvd – Unincorporated Brevard County, Florida – Sec 23, Township 26 South, Range 35 East – Intersection of Pineda Causeway Extension and Brisbane Boulevard
4

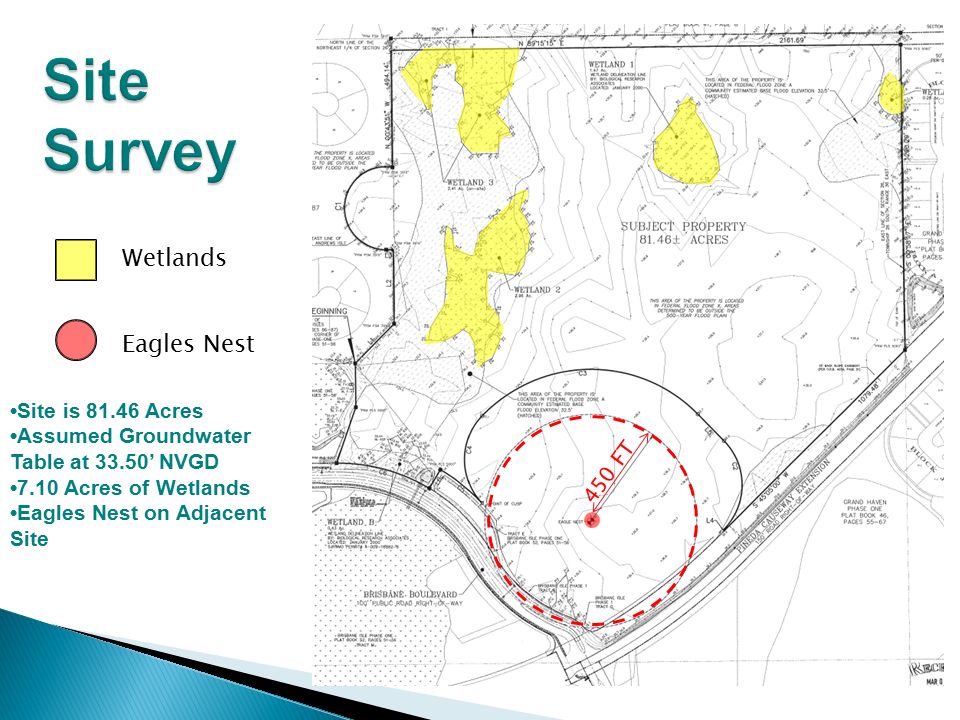

450 FT Wetlands Eagles Nest Site is 81.46 Acres Assumed Groundwater Table at 33.50’ NVGD 7.10 Acres of Wetlands Eagles Nest on Adjacent Site
5

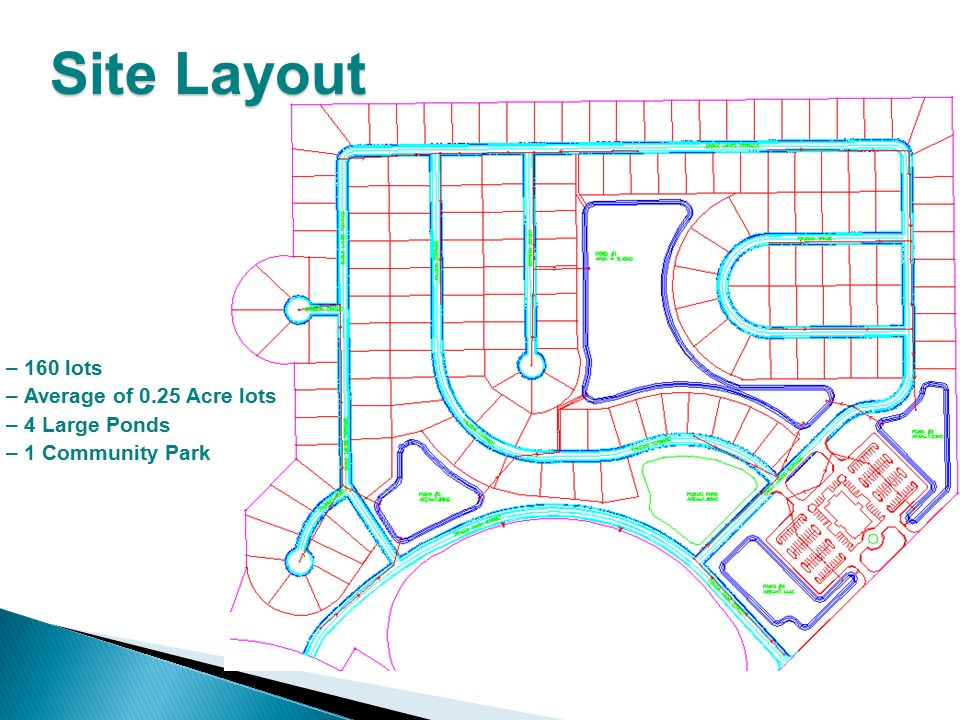

Site Layout – 160 lots – Average of 0.25 Acre lots – 4 Large Ponds – 1 Community Park
8

Removal of conference rooms on third floor Addition of a shearwall throughout the center of the structure. Realignment of the stairwell on both sides Substitute proposed arched roof for a pitched roof
9

Designed Structure with repetitive members Cut down on cost by allowing for bulk purchases Makes construction go quicker and smoother
11

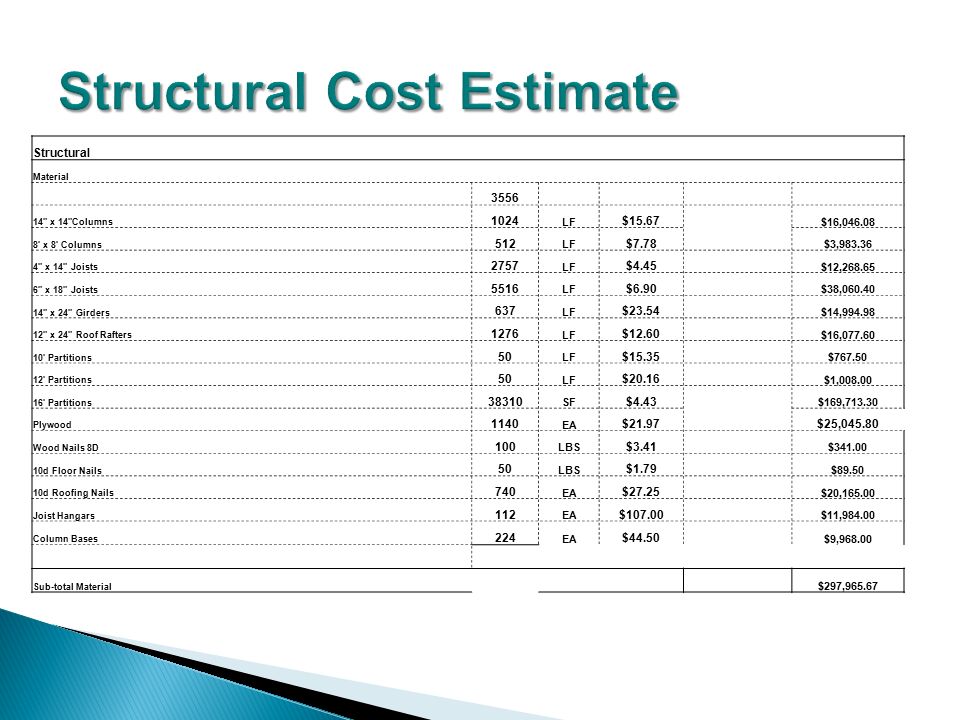

Structural Material 3556 14" x 14"Columns 1024 LF $15.67 $16,046.08 8' x 8' Columns 512 LF $7.78 $3,983.36 4" x 14" Joists 2757 LF $4.45 $12,268.65 6" x 18" Joists 5516 LF $6.90 $38,060.40 14" x 24" Girders 637 LF $23.54 $14,994.98 12" x 24" Roof Rafters 1276 LF $12.60 $16,077.60 10' Partitions 50 LF $15.35 $767.50 12' Partitions 50 LF $20.16 $1,008.00 16' Partitions 38310 SF $4.43 $169,713.30 Plywood 1140 EA $21.97$25,045.80 Wood Nails 8D 100 LBS $3.41 $341.00 10d Floor Nails 50 LBS $1.79 $89.50 10d Roofing Nails 740 EA $27.25 $20,165.00 Joist Hangars 112 EA $107.00 $11,984.00 Column Bases 224 EA $44.50 $9,968.00 Sub-total Material $297,965.67
14

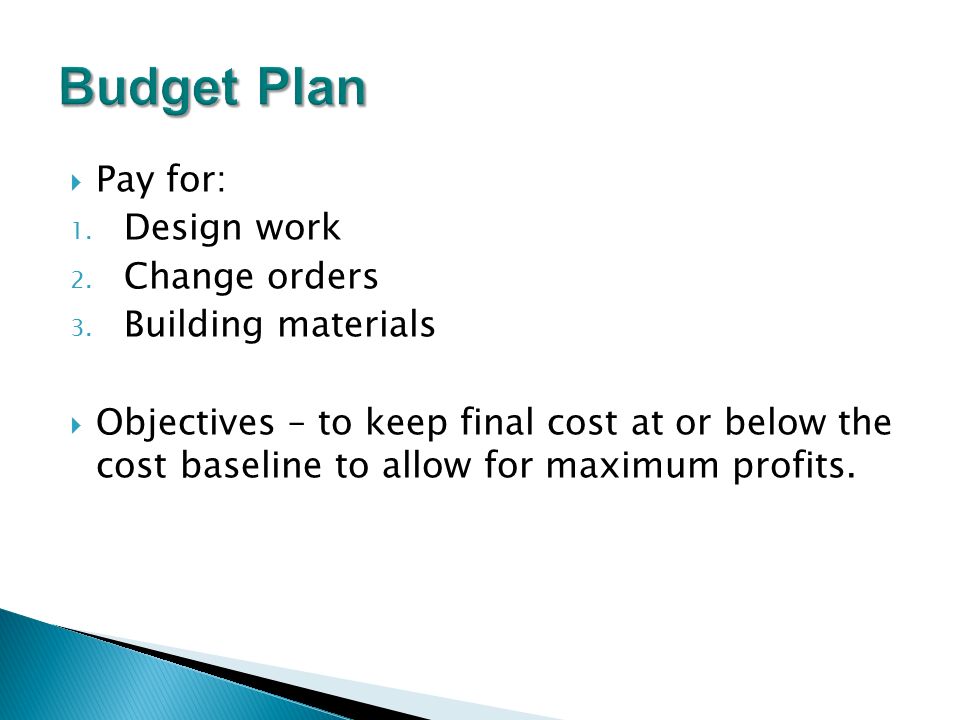

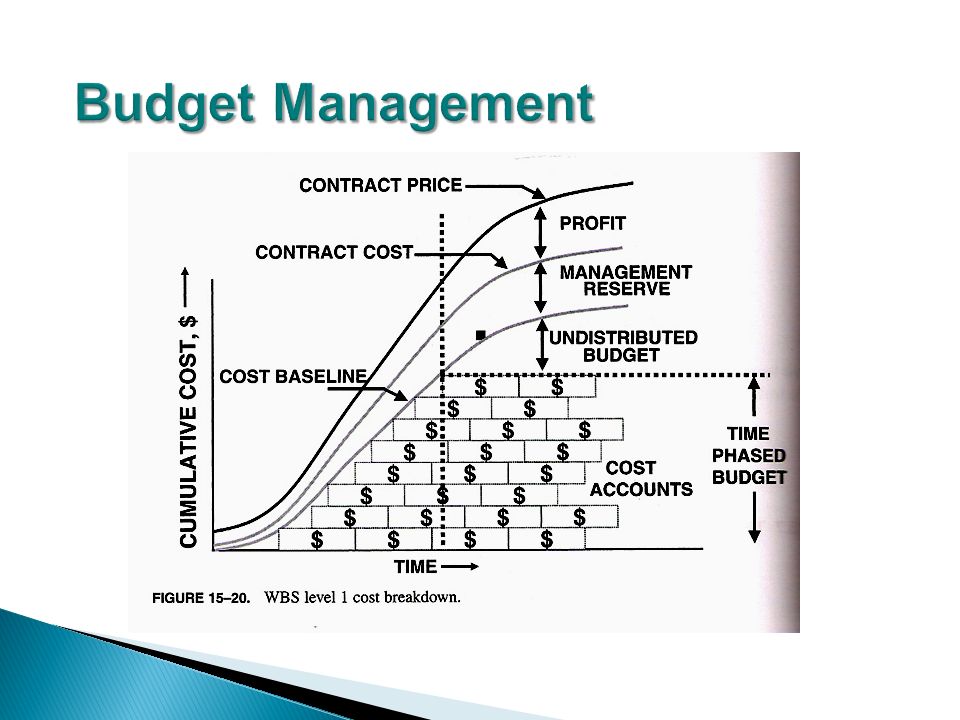

Pay for: 1. Design work 2. Change orders 3. Building materials Objectives – to keep final cost at or below the cost baseline to allow for maximum profits.
16

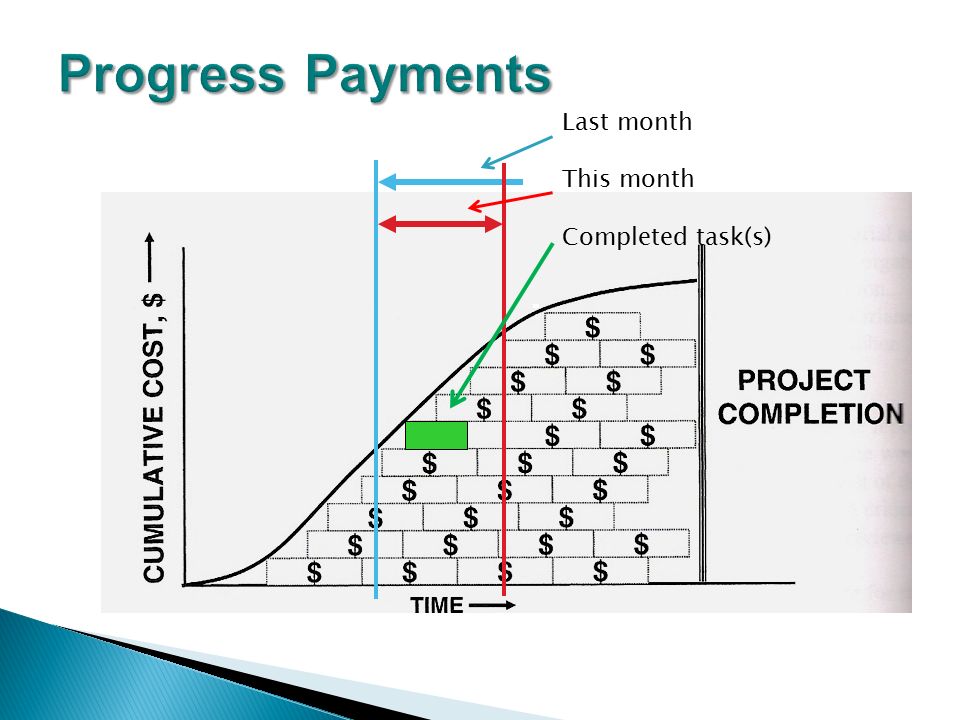

Last month This month Completed task(s)
17
Preparatory inspection – generally a meeting Pre-inspection – prior to placement or cover-up Final inspection – after work completed; prior to payment
18
Design three story office building using all sawn lumber for structural elements. Create a budget plan in order to maximize profits. Create construction schedule to keep project running smooth Implement quality control plan to satisfy the customer
19
If there are any questions feel free to contact me at: Josh Hinkle jhinkle2008@my.fit.edu (239)-634-4656
