USING MS PROJECT 2010 Project management software programs such as Microsoft Project 2010 can be used for developing the project schedule and budget, and.

Similar presentations

Presentation on theme: "USING MS PROJECT 2010 Project management software programs such as Microsoft Project 2010 can be used for developing the project schedule and budget, and."— Presentation transcript:

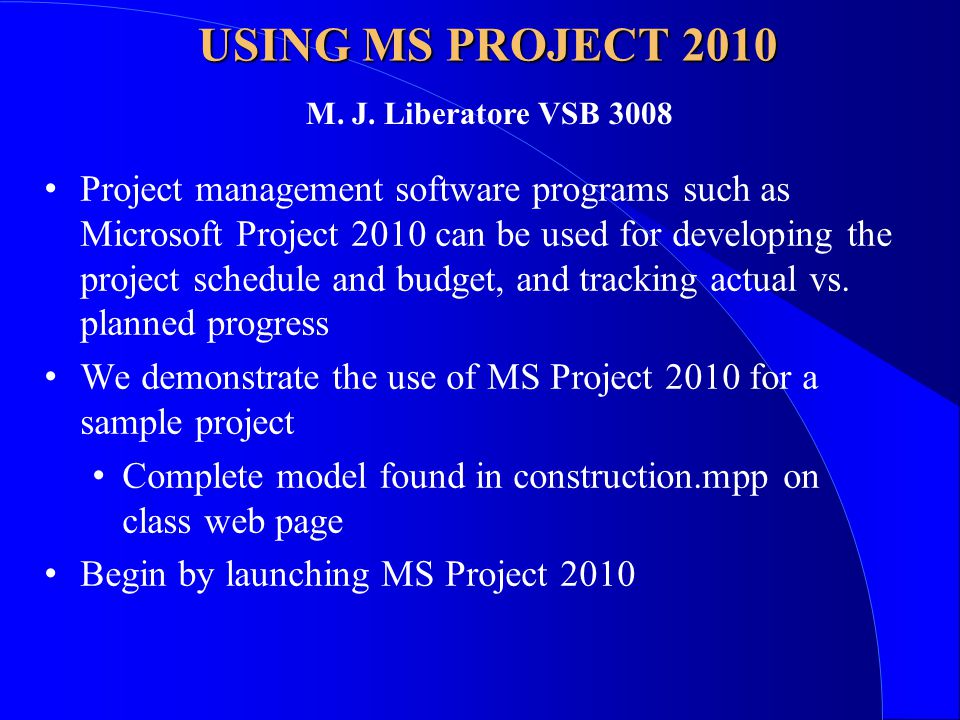

1 USING MS PROJECT 2010 Project management software programs such as Microsoft Project 2010 can be used for developing the project schedule and budget, and tracking actual vs. planned progress We demonstrate the use of MS Project 2010 for a sample project Complete model found in construction.mpp on class web page Begin by launching MS Project 2010 M. J. Liberatore VSB 3008

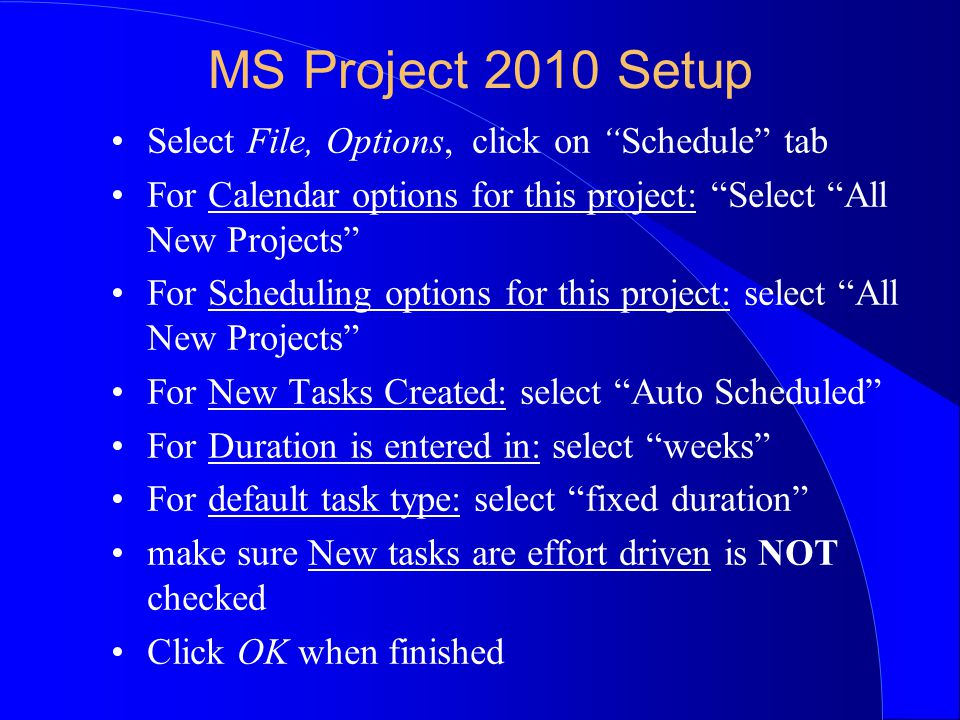

2 MS Project 2010 Setup Select File, Options, click on “Schedule” tab For Calendar options for this project: “Select “All New Projects” For Scheduling options for this project: select “All New Projects” For New Tasks Created: select “Auto Scheduled” For Duration is entered in: select “weeks” For default task type: select “fixed duration” make sure New tasks are effort driven is NOT checked Click OK when finished

3 MS Project 2010 Setup

4 Creating a Project Click on Project, Project Information, select 10/3/11 as the Start date, click OK Click on Save as, type in project name such as Demo, click OK Your project is saved as Demo.mpp

5 Creating a Project

6 Example Project Task, Duration, and Immediate Predecessor Information for Construction Project IMMEDIATE DURATION TASKDESCRIPTION PREDECESSORS(WEEKS) 1START --0 2Excavate and Pour Footers 13 3Pour Concrete Foundation 21 4Erect Rough Wall & Roof 34 5Install Siding 46 6Install Plumbing 43 7Install Electrical 44 8Install Wallboard 6,75 9Lay Flooring 86 10Do Interior Painting 83 11Install Interior Fixtures 9,103 12Install Gutters & Downspouts 52 13Do Grading & Landscaping 123 14FINISH 11,130

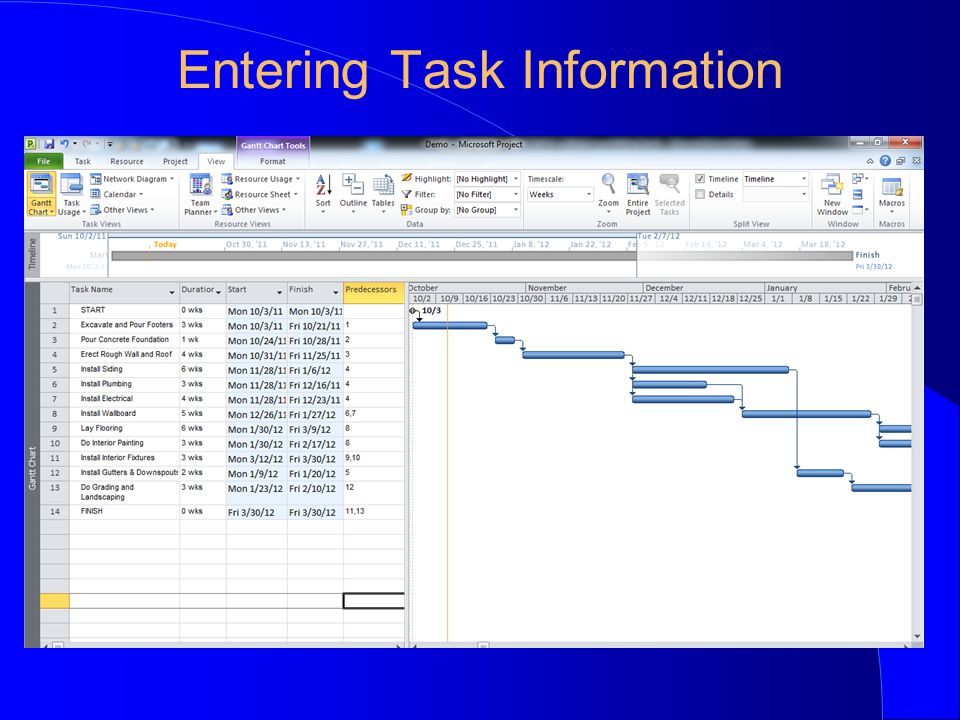

7 Entering Task Information Default view, Entry table on left, Gantt Chart on right You can delete the two left-most columns, “i” and “task mode” by highlighting these columns and pressing the “delete” key (not needed by us) Task numbers now in left-most column Enter task name and duration in their field The default is weeks or “w” “d” for days and “h” for hours can be used Enter predecessor task number(s) in the “Predecessors” field MS Project automatically gives start and finish dates based on critical path analysis

8 Entering Task Information

9 Task Information Double-clicking on a task name opens the Task Information” screen

10 Project Charts The Gantt Chart view shows task linkages Since START and FINISH are dummy activities with 0 duration, they are milestones in MS Project (black diamonds) Right-click on dates in the chart and then “zoom” as desired Change view to Network Diagram by clicking on “View” in the menu and then select “Network Diagram” (zoom as desired)

11 Gantt Chart

12 Network Diagram

13 Critical Path Analysis MS Project 2010 automatically computes the critical path and the earliest and latest start and finish times and slack Project, Project Information, Statistics shows the critical path is 26 weeks in our project

14 Project Critical Path Length

15 Critical Path Analysis Use the “Detail Gantt” to best display the critical path Select “View”, “Other Views”, “More Views”, “Detail Gantt” then “Apply” Use the “Schedule Table” to display all of the early and late start and finish information, along with total and free slack Again from “View”, select “Table”, and then “Schedule”

16 Schedule Table & Detail Gantt

17 Critical Path Analysis Critical path tasks can be identified as those have zero total slack (TS) or float TS = LF – EF = LS – ES The TS of only 1 task can be used if we want to be certain about not delaying the project Free slack (FS) of a task is the difference between the smallest of the ES’s of the task’s immediate successors and the task’s EF. Using FS does not affect the start times of a task’s successors FS <= TS FS of multiple tasks can be used without delaying the project FS is shown on the Detail Gantt

18 Critical Path Analysis Notice that tasks 12 and 13 both have 7 weeks of total slack However, if task 12 uses this slack, it is not available to task 13, so its slack is not free Tasks 12 and 13 are linked, so delaying the start of 12 delays the start of 13 by the same amount

19 Summary Tasks Summary tasks can be used to better organize a project (see constructionS.mpp) We add three summary tasks: Structure, Interior, and Exterior Structure includes current tasks 2 – 4, Interior includes 6 – 11, Exterior includes 5, 12, 13 Example: highlight “Excavate and Pour Footers,” click on “Tasks”, click on” Summary,” enter “Structure” Indent first three tasks under “Structure” by highlighting them and selecting “indent” (thick green arrow going to the right)

20 Creating a Summary Task

Download ppt "USING MS PROJECT 2010 Project management software programs such as Microsoft Project 2010 can be used for developing the project schedule and budget, and."
