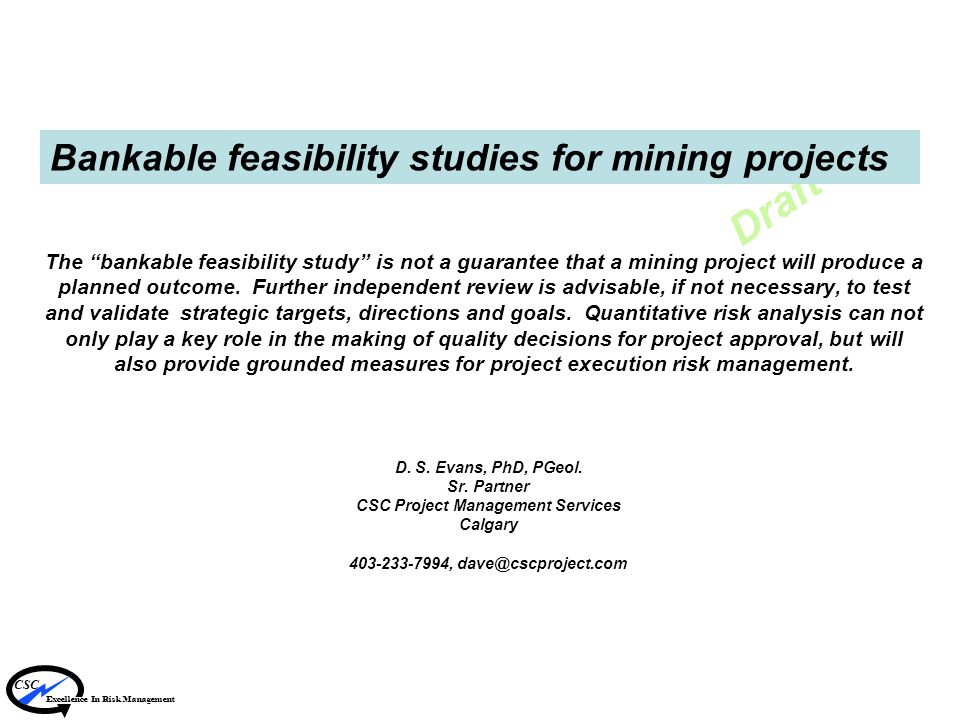

Draft The “bankable feasibility study” is not a guarantee that a mining project will produce a planned outcome. Further independent review is advisable, if not necessary, to test and validate strategic targets, directions and goals. Quantitative risk analysis can not only play a key role in the making of quality decisions for project approval, but will also provide grounded measures for project execution risk management. D. S. Evans, PhD, PGeol. Sr. Partner CSC Project Management Services Calgary 403-233-7994, dave@cscproject.com Bankable feasibility studies for mining projects CSC Excellence In Risk Management
2
Draft Statements, other than statements of historical fact, may constitute forward- looking information and include, without limitation, timing and content of upcoming feasibility studies and other economic or financial analyses; anticipated availability and terms of future financing; future production, operating and capital costs; and operating or financial performance. -OR- Forward-looking information involves various risks and uncertainties. There can be no assurance that such information will prove to be accurate, and actual results and future events could differ materially from those anticipated in such information. Important factors that could cause actual results to differ materially include: fluctuations in commodity prices and currency exchange rates; the need for co-operation of government agencies in the issuance of required permits and approvals; the possibility of delay in development work or in construction and uncertainty of meeting anticipated milestones; and other risks and uncertainties. There are more risks to mining than just commodity price fluctuations…. Limitation Statements define some uncertainties, but not all of them….. CSC Excellence In Risk Management
3
Draft Corporate Performance Exploration Performance Development Performance Mining Performance Processing Performance Marketing Performance Location Uncertainty Mining Complexity Social & Environmental Uncertainty Construction Uncertainty Mining Uncertainty Metallurgical Uncertainty Market & Commodity Pricing Uncertainty Financial & Economic Uncertainty Geological Uncertainty Science & Technology Uncertainty Mining is a risky business and each stage is impacted by uncertainties Investor Uncertainty Social & Environmental Uncertainty Social & Environmental Uncertainty Social & Environmental Uncertainty Social & Environmental Uncertainty Social & Environmental Uncertainty Political Uncertainty Political Uncertainty Investor Uncertainty Pervasive, Largely Uncontrollable Risks Poorly Defined and somewhat Controllable Risks Direct Controllable Risks Global Financial & Economic Risks CSC Excellence In Risk Management “Risk Categories”
4
Draft Definitions & Basis Typically, a bankable feasibility study is a comprehensive forward analysis of a project’s economics (+/-15% precision) to be used by financial institutions to assess the credit- worthiness for project financing. The feasibility part is guided by a set of assumptions, a strategy, development conditions and a planned outcome. The outcome is uncertain and targets and objectives may not be achievable. The bankable part relates to the basis and conditions for a future financial agreement to collateralize mining assets for a project loan, to set a premium and a repayment schedule, with appropriate risk/reward factors.
5

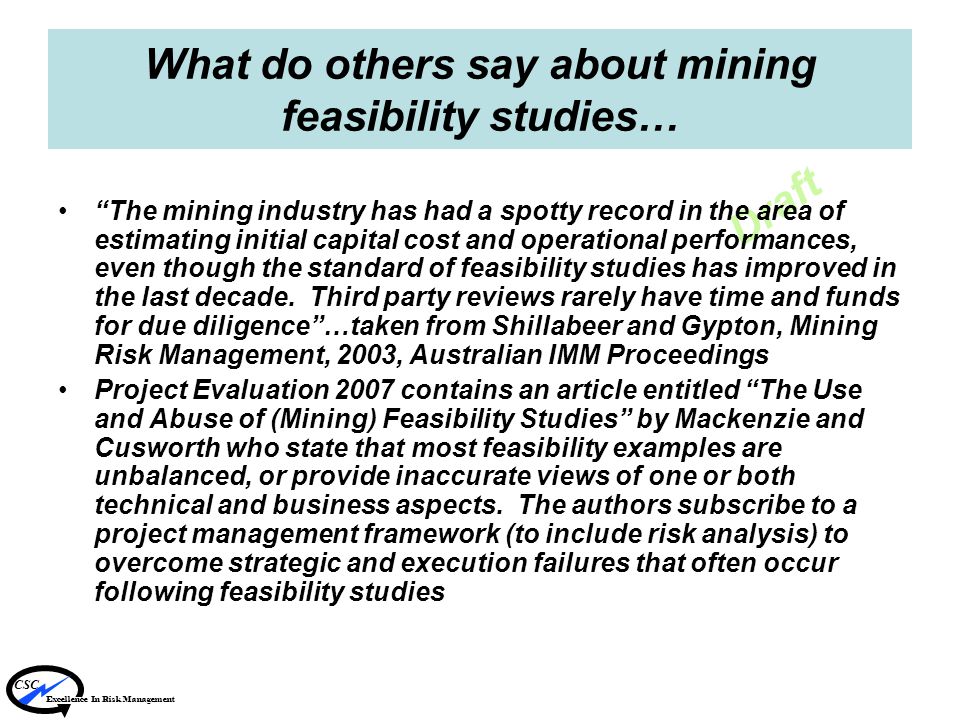

Draft What do others say about mining feasibility studies… “The mining industry has had a spotty record in the area of estimating initial capital cost and operational performances, even though the standard of feasibility studies has improved in the last decade. Third party reviews rarely have time and funds for due diligence”…taken from Shillabeer and Gypton, Mining Risk Management, 2003, Australian IMM Proceedings Project Evaluation 2007 contains an article entitled “The Use and Abuse of (Mining) Feasibility Studies” by Mackenzie and Cusworth who state that most feasibility examples are unbalanced, or provide inaccurate views of one or both technical and business aspects. The authors subscribe to a project management framework (to include risk analysis) to overcome strategic and execution failures that often occur following feasibility studies CSC Excellence In Risk Management
6
Draft So what does +/- 15% really mean? A +/-15% estimate is somewhere between the definition of a Class 5 and Class 2 estimate. Class has to do with both the content and quality of the estimate and the estimating confidence (precision). Well, doesn’t contingency cover estimate shortfalls (+15%)? Contingency is a separate decision in support of the estimate to resolve cost uncertainty precision. Current thinking is that contingency will be “used up” for some, but not all cost categories. Contingency does NOT make the estimate “more accurate”. Quantitative Risk Analysis is a process to assess and quantify the potential variances around project drivers. When key project drivers (i.e. risks) become quantified, corrective measures and actions can be taken, with confidence, in the making of quality decisions about precision and accuracy. CSC Excellence In Risk Management
7
Draft Normally, a feasibility study is prepared by a qualified engineer or estimator. It is a forward-looking document that captures a precision level but not necessarily an acceptable* level of accuracy. So, what does “bankable feasibility” really mean in terms of accuracy for owner and investor confidence in the development and construction of a mining project? And how does risk analysis capture precision and accuracy for better decision-making and executing a transparent, accountable and defensible execution plan? The bankable feasibility study as a comprehensive engineering study, cost estimate and mining development plan CSC Excellence In Risk Management * As known or required by the project owner
8

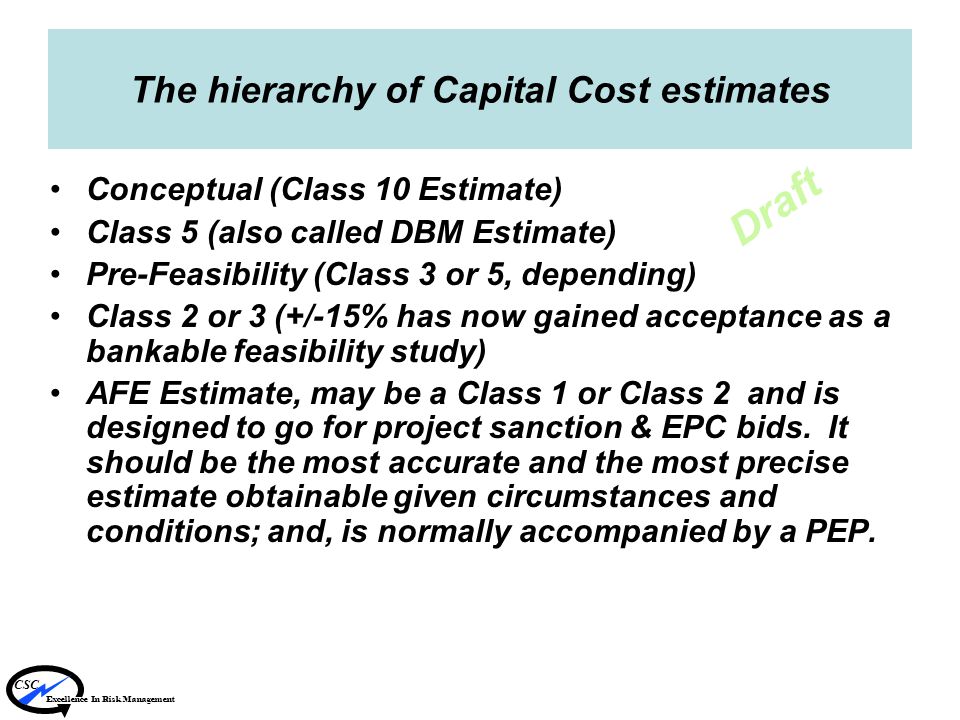

Draft The hierarchy of Capital Cost estimates Conceptual (Class 10 Estimate) Class 5 (also called DBM Estimate) Pre-Feasibility (Class 3 or 5, depending) Class 2 or 3 (+/-15% has now gained acceptance as a bankable feasibility study) AFE Estimate, may be a Class 1 or Class 2 and is designed to go for project sanction & EPC bids. It should be the most accurate and the most precise estimate obtainable given circumstances and conditions; and, is normally accompanied by a PEP. CSC Excellence In Risk Management
9
Draft Precision and accuracy are separate variables in the Cost Estimate “Precision”“Accuracy” Precision is the ability to reproduce a result; Accuracy is a confidence in the absolute result or outcome.
10
Draft The Definition of Estimate Classes The Study or Class 5 estimate is prepared in conjunction with the Design Basis Memorandum phase of the project. At this point all critical design alternatives have been examined and the preliminary project execution plan has been established. This type of estimate is defined as “an estimate, including contingency, that has a probability of overrun by more than 10%, 1 time in 3”. The AFE or Class 2 estimate is prepared in conjunction with the Basic Engineering phase of a project. At this point, all key design documents such as P&ID’s, layouts and electrical single lines have been established. The project execution plan, construction plan, and schedule have also been established. This type of estimate is defined as where “the final cost of the project will be within plus or minus 10% of the estimated value, 80% of the time”. CSC Excellence In Risk Management
11
Draft Class II AccuracyClass V Accuracy 0% 10% 20% 30% 40% 50% 60% 70% 80% 90% 100% 180200240 Probability $MM Base estimate plus contingency 200 $MM P50 = 200 $MM P10 =180 $MM -10% P90 =220 $MM +10% 0% 10% 20% 30% 40% 50% 60% 70% 80% 90% 100% 180200220 Probability $MM P50 = 200 $MM P10 =168 $MM -19% P90 =237 $MM +19% 160 240 Final cost will be within +/- 10% of the estimate, 80% of the time Estimate including contingency, has a probability of 10% overrun, 1 time in 3. Base estimate plus contingency 200 $MM The definition of estimate classes describes the expected range of uncertainty around an estimate (in assessment and simulation this is the slope of the probability distribution) P90-P10 = 80% P67.7 crosses at 10% over estimate CSC Excellence In Risk Management
12
Draft 0% 10% 20% 30% 40% 50% 60% 70% 80% 90% 100% 120160200240280 Probability $MM Base = 160 $MM P50 = 200 $MM P10 =178 $MM -9% P90 =222 $MM +11% Quantitative risk analysis calculates the probability distribution of a cost outcome This distribution can be used to : 1. Determine the contingency required for any confidence level (probability). 2. Compare the estimate uncertainty (slope) with other estimate class definitions. Slope of Class V Estimate Slope of Class 2 Estimate 40 $MM Contingency Required for P50 Confidence CSC Excellence In Risk Management
13
Draft A example of risk analysis applied to a mining capital cost estimate CSC Excellence In Risk Management
14
Draft Materials/ Estimate Variance Total Project CAPEX $ 171,682k Indirects $ 20,001k Mill $58,387k Mine $ 53,635k $ 38,215k Level Excavation $ 3,799k Shaft Excavation $5,179k Water $ 1,270k Roads The CAPEX Influence Diagram for a UG Mining Construction Project $ 11,121k Miscellaneous Bid Rate Engineering Cost Variance Organization Performance Competing Projects Labour Productivity $22,088k Contingency @ 15% $ 2,592k Administration $ 17,409k EPCM Exchange Rate ($ 1,602k/yr) Sustaining Capital Local Benefits Cost Variance Subsurface Equipment $ 11,621k $ 17,570k Infrastructure Used Equipment Labour Rate Scope Variance CSC Excellence In Risk Management
15
Draft From the probabilistic simulation conducted during the quantitative risk analysis, the Expected Value output of Total CAPEX is $ 181 MM, which is $ 9 MM above the Base with contingency. BaseExpectedP10P90 Mine CAPEX53.6 66.649.185.7 Mill CAPEX58.460.658.363.5 Infrastructure17.623.616.035.3 Indirects20.030.521.642.1 Contingency22.1 0.0 0.0 0.0 Total CAPEX 172 $MM 181 $MM 151 $MM 212 $MM CSC Excellence In Risk Management Expected Value is P55 or about a 55% chance of happening P10 & P90 are each about a 10% chance of happening and define the range of this outcome which is a measure of the accuracy of the estimate
16
Draft Total CAPEX 0 10 20 30 40 50 60 70 80 90 100 050100150200250 Probability $MM The Base Capital Cost estimate is $ 172 MM. The expected Total Capital Cost is $ 181 MM. In this case there is only a 39% chance that the project will achieve the CAPEX Base Case estimate with contingency Mill Base 58 $MM Mine Base 54 $MM Base with contingency ( 172 $MM) EV = 181 $MM Mill CAPEX EV = 61 $MM Mine CAPEX EV = 67 $MM Total CAPEX EV = 181 $MM CSC Excellence In Risk Management
17
Draft -15-10-505101520 Mine Unit Cost Variance - Multiplier 11.5 Mine Quantities Variance - Multiplier 0.861.26 Competing Projects Environment CoolHeated Level Excavation Scope Variance- Multiplier 0.841.18 Infrastructure Costs 0.72 Execution Organization Performance ExcellentPoor Infrastructure Construction Duration - Months 712 Regulatory Process Duration - Months 1034 Tailings Cost Variance - Multiplier 0.86 Road Cost Variance -Base - 1.27 MM 2.57 Subsurface Equipment Costs 1.011.3 Mine Construction Duration - Months 1828 EPCM Cost Variance -Base - 9.6 + 6.7MM 15.5% 0.120.14 Community Negotiations & Agreements Duration - Months 1125 Water Cost Variance -Base - 5.2 MM 4.27 Total Capital Expenditure $MM 181 $MM The Range in CAPEX is largely due to uncertainty in Mine Unit Cost Variance, Mine Quantities Variance and Level Development Scope Variance. CSC Excellence In Risk Management
18
Draft 140 150 160 170 180 190 Schedule +7 Mine Costs +12 Mill Costs +2 Infrastructure Costs +9 Labour Costs 0 Indirect Costs Total CAPEX EV = 181 $MM Base = 150 $MM $MM Expected increases to Construction Costs add $ 23 MM to the Base CAPEX Estimate. Schedule Impacts add $ 7 MM. CSC Excellence In Risk Management
19
Draft Strategy Execution Flawed Sound Sound Doomed from the Beginning A Botched Job Flirting with Disaster A Pretty Good Chance CSC Excellence In Risk Management In absolute terms, there is about a one in four chance of getting the “right” strategy paired with the “right” execution plan for the “planned outcome”… Flawed...the idea is to get it approximately right rather than perfectly wrong... A planned outcome requires a sound strategy and a sound execution plan
20
Draft Bankable Feasibility Studies for Mining Projects….things to remember. Accuracy and precision are different. Accurate estimates are precise, but precise estimates are not necessarily accurate. Beware of the Halo Effect: the tendency to believe and place faith that your strategy and execution plan are sound, grounded, etc.; The Delusion of Absolute Performance: any given formula cannot ensure high organizational performance, etc.; The Delusion of Lasting Success: enduring success is not sustainable; Recognize the Role of Uncertainty: adjust your thinking to accommodate uncertainty (risk & opportunity!) and make better decisions; See your Project through Probabilities: approach problems as interlocking internal and external probabilities; Separate Inputs from Outcomes: actions and outcomes are imperfectly linked. It is easy to infer that bad outcomes must mean somebody made mistakes, or a good outcome must mean somebody made good decisions (or got lucky!); There are more things that can go wrong rather than right in execution: determine the project drivers, assess & quantify risk and develop a risk management plan to build better valued projects; CSC Excellence In Risk Management
21
Draft A Final Note…. We often hear the phrase “We have to get cost certainty or else……) We are rarely told what the “or else” is, but it sounds pretty awful. In these circumstances, CSC takes the position that owners, their consultants and contractors to look for the value proposition in their development and construction projects. Should your project go over budget, or goes long, make sure that the project achieves value in the completed cost. When the project delivers value that respects or justifies the cost, then it is a good project.
22
Draft Specifics: Supports Owner Organizations in major project development. Group formed in 1982, over 350 project assignments in 7 countries. Extensive and varied background in Project Planning and Management. Specialties: Risk & Decision Analysis for a wide range of capital Projects. Strategic & Mitigation Planning for projects using risk models. Facilitation of Project Management, Business Planning, Environmental & Safety Planning & Management and Team Building. Project Management Education Workshops. Development of Contract Claims and disputes and litigation support. CSC Excellence In Risk Management
