1
construction What is “construction” defined as or include? Building? Altering ? Repairing? Demolishing? Public Improvements?
2
What does “construction” NOT include? Routine operation Routine repair Routine maintenance
3
Major Types of Construction Solicitations or Construction Contracts (allowed under A.R.S., Title 34): Design-Build Design-Bid-Build Job-Order-Contracting Construction Manager at Risk Simplified Construction (A.R.S. 41-2535)
4
Design-Build Single contract for design and construction Separate contracts can be used Preconstruction services Construction services Basis of Award: Demonstrated competence and qualifications
5
Design-Build cont. Advantages Faster Delivery Cost Savings Better Quality Singular Responsibility Decreased Administrative Responsibility Reduced Risk Reduced Litigation Claims
6

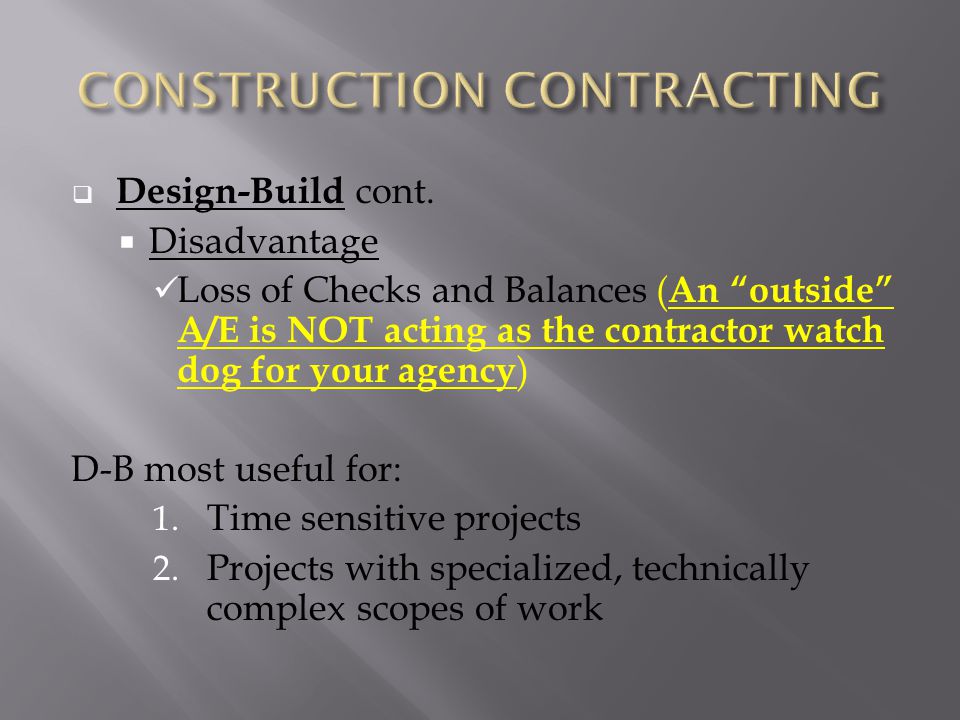

Design-Build cont. Disadvantage Loss of Checks and Balances ( An “outside” A/E is NOT acting as the contractor watch dog for your agency ) D-B most useful for: 1. Time sensitive projects 2. Projects with specialized, technically complex scopes of work
7
Design-Bid-Build (“similar” to Invitation for Bid) Sequential Award (Two Separate Contracts) Design Contract Construction Contract Design and Construction are non-concurrent D-B-B contracts do not include: Finance Services (financing for construction services) Maintenance Services Operation Services Good choice for simple projects with small number of change orders
8

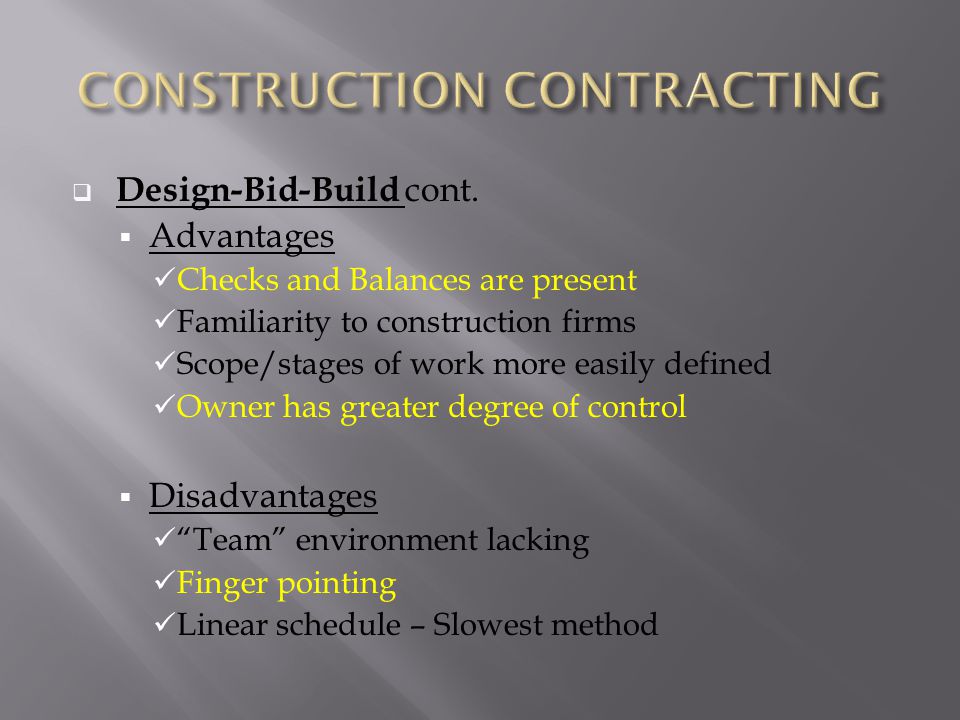

Design-Bid-Build cont. Advantages Checks and Balances are present Familiarity to construction firms Scope/stages of work more easily defined Owner has greater degree of control Disadvantages “Team” environment lacking Finger pointing Linear schedule – Slowest method
9
Job Order Contracting Invented by COL Mellon (U.S. Army) for NATO for routine maintenance and alteration of U.S. Army facilities in Europe IDIQ contract Multiple contracts for multiple years (5 years max) Incorporates a “Unit Price Book” (Ex. RS Means or equiv.) and coefficient markup for line items in Unit Price Book Basis of Award: Most Qualified Firm(s)
10
Job Order Contracting cont. Advantages Fast, responsive and time savings Simplicity (for repetitive types of work) Longer term relationships with contractor Disadvantages Potential reduces contracting opportunities for other contractors Learning curve implementing JOC Limited to projects less than $1,000,000 Possibly more expensive than other alternatives
11
Construction Manager at Risk (CMAR) Sequential Award (Two separate Contracts) Design Contract Construction Contract (Pre-Construction Phase/Construction Phase) Design and Construction can be concurrent Construction Manager is brought in early during the design phase and proposes GMP near the end of the Design Development Phase(s) Used for large, time sensitive, requiring extensive management, multi-trade, technically complex projects Basis of Award: Contractors demonstrated competence and qualifications
12
Construction Manager at Risk cont. Advantages Increased speed (Contractor(s) is/are chosen before design is 100% complete) Contractor is selected based on demonstrated qualifications Contractor and A/E work as a team Separation of duties between contractor and A/E Greater/enhanced transparency (bids are open to inspection)
13
Construction Manager at Risk cont. Disadvantages Difficult to know if lowest bid is achieved (compared to D-B-B process) CMAR jobs tend to cost more
14
Simplified Construction Authorized by: A.R.S. 41-2535 ($100k or less) A.R.S. 15-213 ($150k or less) – State Board of Education/School Restricted, if “practicable” to small businesses Pursuant to rules adopted by “director” Maricopa County requires 3 written quotes Vendor list is maintained of “persons” who are interested with additions permitted throughout year Think of D-B-B and Request for Quotation (for goods/services)
15
Bonds Three types of Construction Bonds: Bid Bond - Guarantees the contractor will honor its bid and will sign all contract documents if awarded the bid. Performance Bond - Guarantees the contractor will complete the contract according to its terms including price and time. Payment Bond - Guarantees the subcontractors and suppliers will be paid monies that that are due from the contractor.
16
Bond Submittals Bonds can be submitted as a Surety Bond or In the form of a certified check or cashiers check in the amount(s) required.
17
Bond Ratings What type of rating should your agency specify and why? Bond Rating/Financial Strength: (A.M. Best Ratings) SecureVulnerable A++, A+ (Superior)B, B- (Fair) A, A- (Excellent)C++, C+ (Marginal) B++, B+ (Good)C, C- (Week) D (Poor) E (Under Regulatory Supervision) F (In Liquidation) S (Suspended)
18
BOND SAMPLE LANGUAGE: All Insurers and Sureties shall have at the time of submission of the proposal an A.M. Best’s Key Rating Guide of “A-” or better as currently listed in the most recent Best Key Guide, published by the A.M. Best Company, payable without condition to the Owner.
19
Construction Bond Matrix Design Services Design/ Build Design-Bid- Build (low bid) JOCCM @ Risk Bid BondNone 10% (Budget for Construction) A.R.S. 34-608 10% (Contractors Bid) A.R.S. 34-608 10% (1 st years Construction Budget) A.R.S. 34-608 None Performance Bond None 100% (Construction contract amount) A.R.S. 34-610 100% (Construction contract amount) A.R.S. 34-222 100% (Construction contract amount) A.R.S. 34-610 Payment BondNone 100% (Construction contract amount) A.R.S. 34-610 100% (Construction contract amount) A.R.S. 34-222 100% (Construction contract amount) A.R.S. 34-610 100% (Construction contract amount) A.R.S. 34-610
