1 Project management

2 Software project management ■It is the discipline of planning, organizing and managing resources to bring about the successful completion of specific project goals and objectives. ■Requires professional skills. ■Includes 2 very crucial aspects: Planning and Control. ■The goal is to ensure prompt completion times, minimum costs, and required functionality.

3 Management activities ■Proposal writing. ■Project planning and scheduling. ■Project costing. ■Project monitoring and reviews. ■Personnel selection and evaluation. ■Report writing and presentations.

4 Project planning  Planning is the most important project management activity.  It has two basic objectives:  Establish reasonable cost, schedule, and quality goals for the project.  Draw out a plan to deliver the project goals.  The inputs to the planning activity are :  The requirements specification.  The architecture description.  A very detailed requirements document is not essential for planning, but for a good plan all the important requirements must be known, and it is highly desirable that key architecture decisions have been taken.

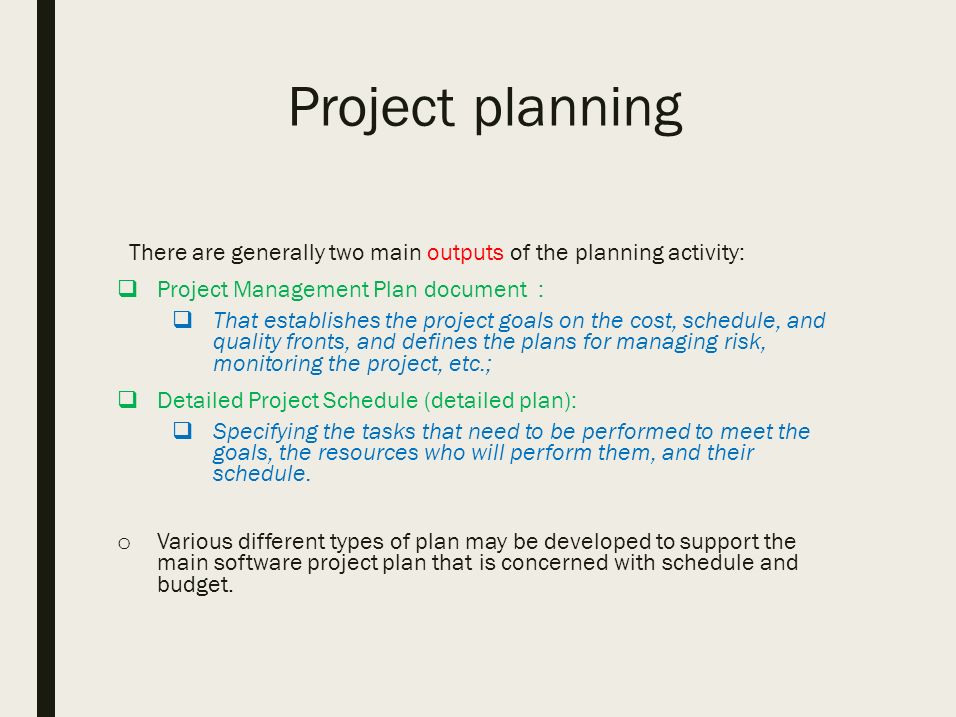

5 Project planning There are generally two main outputs of the planning activity:  Project Management Plan document :  That establishes the project goals on the cost, schedule, and quality fronts, and defines the plans for managing risk, monitoring the project, etc.;  Detailed Project Schedule (detailed plan):  Specifying the tasks that need to be performed to meet the goals, the resources who will perform them, and their schedule. o Various different types of plan may be developed to support the main software project plan that is concerned with schedule and budget.

6 Types of project plan

7 The project plan ■The project plan sets out: –The resources available to the project; –The work breakdown; –A schedule for the work.

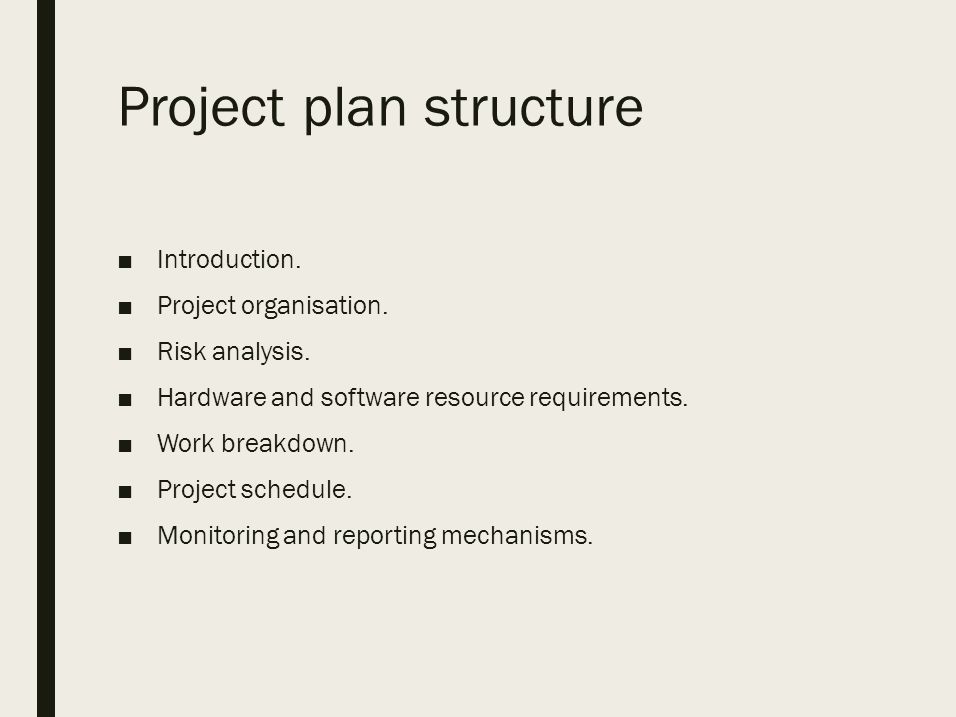

8 Project plan structure ■Introduction. ■Project organisation. ■Risk analysis. ■Hardware and software resource requirements. ■Work breakdown. ■Project schedule. ■Monitoring and reporting mechanisms.

9 Effort Estimation  For a software development project, overall effort and schedule estimates are essential prerequisites for planning the project.  These estimates are needed before development is initiated, as they establish the cost and schedule goals of the project(Why?).  Without these, even simple questions like “is the project late?” “are there cost overruns?” and “when is the project likely to complete?” cannot be answered.

10 Effort Estimation  Size of the software is a major factor in determining how much effort is needed to build it. That is, the larger the project, the greater is the effort requirement. lines of code )  Software Size can counted in terms of LOC, KLOC ( lines of code ).  Work effort (man-months) is the labor required to complete an activity.  Work effort is typically the amount of focused and uninterrupted labor time required to complete an activity. (P/H), (P/M), (S/M), (M/H).(person/month).

11 Effort Estimation There are two commonly used approaches in estimating effort:  Top-Down Estimating Approach : analogy, group consensus, or mathematical relationships  Bottom-Up Estimating Approach: estimates of elements of the work breakdown structure.

12 Top-Down Estimating Approach ■The top-down approach considers effort as a function of project size. ■This approach can work only if the size and type of the project are similar to the set of projects from which the productivity P was obtained (and that in the new project a similar productivity can be obtained by following a process similar to what was used in earlier projects). ■In Top-Down approach for estimation of effort, some equation is used to estimate the total effort required for entire project.

13 Top-Down Estimating Approach A more general function for determining effort from size that is commonly used is of the form: EFFORT = a * SIZE b ■project size is generally in KLOC based on project type/complexity: ■where a and b are constants its change based on project type/complexity:

14 Example The lead developer is consulted to give estimate of the expected size of the new project. The opinion is that this project will be about 50,000 lines of C++. Calculate the effort (man/hour). Note : The project type is Organic.

15 Bottom-Up Estimating Approach:  In this approach, the estimate is first obtained for every parts of the project, then the overall estimate is obtained.  This type of approach is also called activity-based estimation.  This approach does not require size to be estimated.  This approach is also used when a project involves mix of different software language & technologies, making size estimation difficult.

16 Bottom-Up Estimating Approach: The risk involved in bottom-up approach are:  Miss some important activity  Difficult to estimate task overhead (project management which can span the entire project)

17 Conclusion..  Both top-down & bottom-up approach require information about the project to estimate –Size for Top-Down approach –List of task for Bottom-Top approach  Both types of estimates become more accurate if more information is available about the project or as the projects proceeds.

18 Project staffing ■May not be possible to appoint the ideal people to work on a project –Project budget may not allow for the use of highly- paid staff; –Staff with the appropriate experience may not be available; –An organisation may wish to develop employee skills on a software project. ■Managers have to work within these constraints especially when there are shortages of trained staff.

19 Project scheduling. ■person and months are not fully interchangeable in a software project. ■Person and months can be interchanged only if all the tasks in the project done in parallel, and no communication is needed between people performing the tasks. ■This is not true for software projects—there are dependencies between tasks, and a person performing some task in a project needs to communicate with others performing other tasks.

20 Project scheduling.  once the effort is fixed, there is some flexibility in setting the schedule by appropriately staffing the project, but this flexibility is not unlimited.

21 Project scheduling ■Split project into tasks and estimate time and resources required to complete each task. ■Organize tasks concurrently to make optimal use of workforce. ■Minimize task dependencies to avoid delays caused by one task waiting for another to complete. ■Dependent on project managers intuition and experience.

22 The project scheduling process

23 Bar charts and activity networks ■Graphical notations used to illustrate the project schedule. ■Show project breakdown into tasks. Tasks should not be too small. They should take about a week or two. ■Activity charts show task dependencies and the critical path. ■Bar charts show schedule against calendar time.

24 Task durations and dependencies

25 Activity network

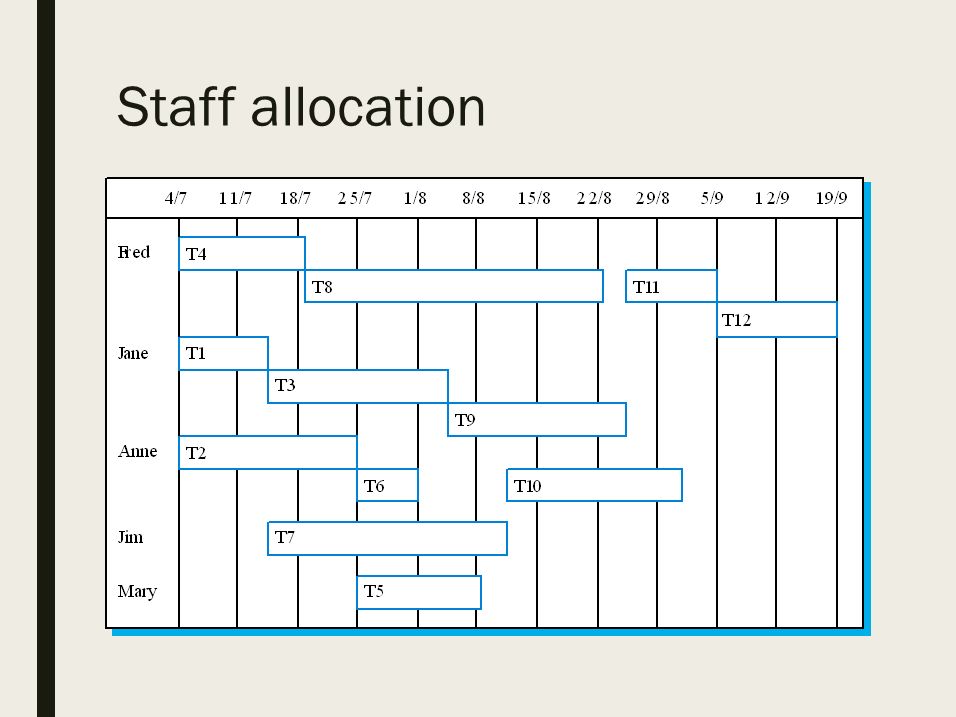

26 Staff allocation

27 Risk management.. ■Risk is defined as an exposure to the chance of injury or loss. ■A risk is a probabilistic event—it may or may not occur. ■A risk is a probability that some adverse circumstance will occur –Project risks affect schedule or resources; –Product risks affect the quality or performance of the software being developed; –Business risks affect the organisation developing or procuring the software.

28 Risk management ■The aim of risk management is not to avoid getting into projects that have risks but to minimize the impact of risks in the projects that are undertaken. ■Risk management has to deal with identifying the undesirable events that can occur, the probability of their occurring, and the loss if an undesirable event does occur. ■Risk management revolves around risk assessment and risk control.

29 Software risks

30 The risk management process ■Risk identification –Identify project, product and business risks; ■Risk analysis –Assess the likelihood and consequences of these risks; ■Risk planning –Draw up plans to avoid or minimise the effects of the risk; ■Risk monitoring –Monitor the risks throughout the project;

31 The risk management process

32 Risk identification ■Risk identification is the first step in risk assessment, which identifies all the different risks for a particular project. ■Checklists of frequently occurring risks are probably the most common tool for risk identification. Risk type : ■Technology risks. ■People risks. ■Organisational risks. ■Requirements risks. ■Estimation risks.

33 Risks and risk types

34 Risk analysis ■In risk analysis, the probability of occurrence of a risk has to be estimated, along with the loss that will occur if the risk does materialize. ■Probability may be very low, low, moderate, high or very high. ■Risk effects might be catastrophic, serious, tolerable or insignificant. ■Once the probabilities of risks materializing and losses due to materialization of different risks have been analyzed, they can be prioritized. ■One approach for prioritization is through the concept of risk exposure (RE).

35 Risk analysis (i)

36 Risk planning ■Consider each risk and develop a strategy to manage that risk. ■Avoidance strategies –The probability that the risk will arise is reduced; ■Minimisation strategies –The impact of the risk on the project or product will be reduced; ■Contingency plans –If the risk arises, contingency plans are plans to deal with that risk;

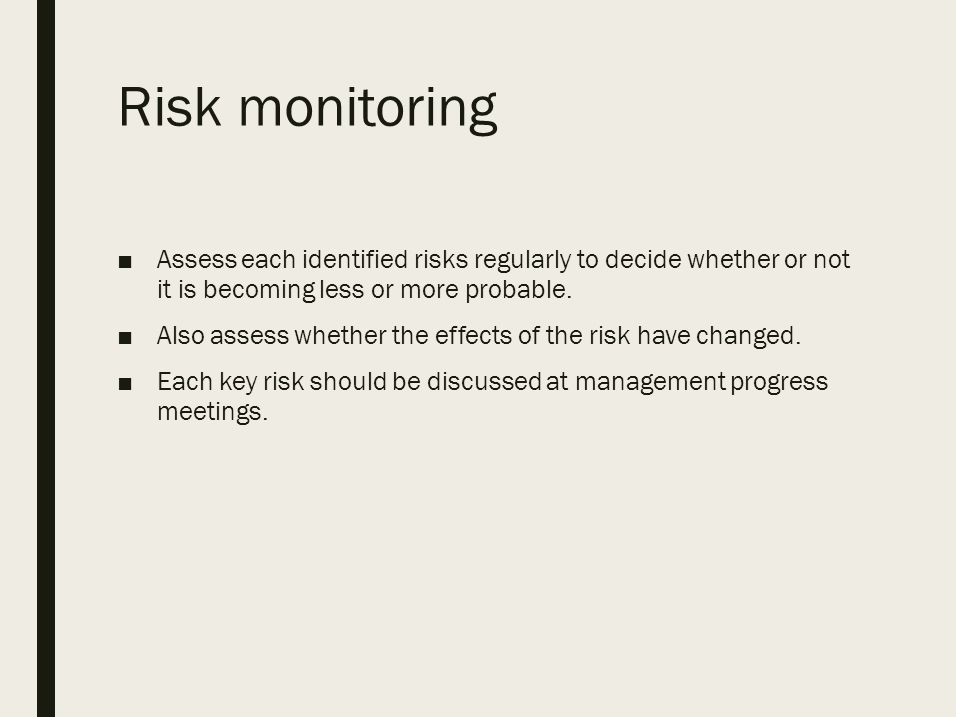

37 Risk monitoring ■Assess each identified risks regularly to decide whether or not it is becoming less or more probable. ■Also assess whether the effects of the risk have changed. ■Each key risk should be discussed at management progress meetings.

38 Risk indicators
